Switchgear Price in Bangladesh: FOB Cost Breakdown for Buyers
Switchgear price in Bangladesh is a system price, not a device price. This guide breaks an FOB panel quotation into its cost lines, ratings, and documents, so buyers can compare suppliers on the same scope.
Short answer
There is no single switchgear price in Bangladesh. Each panel is priced for its scope, ratings, device selection, quantity, and delivery term, so compare only itemised quotations for the same assembly on the same FOB terms. Ask for the cost lines, the per-model test report, and the packing specification in writing before you accept a figure.

On this page
Key takeaways
There is no single switchgear price in Bangladesh: each panel is priced for its scope, ratings, device selection, quantity, and delivery term.
Under FOB, the seller delivers loaded on board at the named port of shipment, and risk transfers to the buyer at that point; ocean freight and import costs sit outside the FOB price.
An itemised quote separates breakers, protection and metering, busbar and wiring, enclosure, assembly, testing, packing, and origin transport.
Ratings and test standards are per-model verification items: ask for the test report for the exact model and rating quoted, not a catalogue page.
Compare only quotations for the same scope, ratings, and delivery term, with the named port, packing specification, and vessel notice procedure in writing.
A switchgear quotation from Bangladesh is hard to compare until you know what sits inside it. One supplier may quote a complete low-voltage distribution board, another the same board without protection relays, current transformers, or export packing, and both figures may be labelled FOB. This guide takes the switchgear price in Bangladesh apart line by line, so you can ask every supplier for the same breakdown.
Switchgear here means the equipment that controls, protects, and distributes electricity: circuit breakers, switches, fuses, relays, and the boards, panels, and cabinets fitted with two or more of those devices. A loose breaker and a fully wired panel are different products with different cost structures, and the first job in any enquiry is to say which one you are buying.
Why this matters for buyers and sellers
For the buyer, the FOB price decides the budget up to loading and how much risk stays with the seller. For the seller, an itemised price protects the order: copper busbar, a specified breaker frame, and a tested assembly cannot be swapped for cheaper parts after agreement without changing what was sold. The Incoterms 2020 rules set out 11 rules with a clear allocation of cost, risk, and obligations.1
Under FOB in Incoterms 2020, the seller delivers the goods loaded on board the vessel nominated by the buyer at the port of shipment, and at that point risk transfers to the buyer.2 The seller transports the goods to the port, loads them, and completes export formalities, while the buyer contracts the carrier, pays freight, and handles import formalities.2 An FOB switchgear price therefore covers the equipment and origin-side work up to loading, not ocean freight, import duty, or delivery at your site. Compare FOB only with FOB, and use the landed cost for imports from Bangladesh guide to add the charges that follow.
One caution applies to container shipments. If the goods are containerised, the seller typically delivers them to a container terminal rather than on board the vessel, and in such cases FCA is the more appropriate rule.2 If a supplier quotes FOB for a containerised panel shipment, ask which point the price runs to and record the answer.
What should I know first about switchgear?
Start with the assembly, not the headline price. A distribution board is a system: an incoming breaker, outgoing feeders, busbars sized for the load, metering, protection, wiring, and an enclosure rated for where the board will sit.
Classification follows the same split. Heading 8537 covers boards, panels, consoles, desks, cabinets, and other bases equipped with two or more apparatus of heading 8535 or 8536, for electric control or the distribution of electricity.3 It splits at 1,000 volts: 8537 10 up to 1,000 volts, and 8537 20 above 1,000 volts.3 A loose breaker sits under heading 8535 or 8536 depending on its voltage. Ask the supplier to state the heading it is quoting under, because the heading on the invoice, packing list, and export declaration must match.
Ratings and test standards are verification items, never a supplier claim to accept at face value. IEC 61439-2 defines the specific requirements for power switchgear and controlgear assemblies for a rated voltage not exceeding 1,000 volts AC or 1,500 volts DC.4 IEC 62271-212 covers compact equipment assemblies for distribution substations for AC voltages up to 52 kV.5 Ask which part of which standard the quoted assembly is built and tested to, and ask for the test report that matches the exact model and rating, not a report for a different frame size.
Step-by-step: how it works

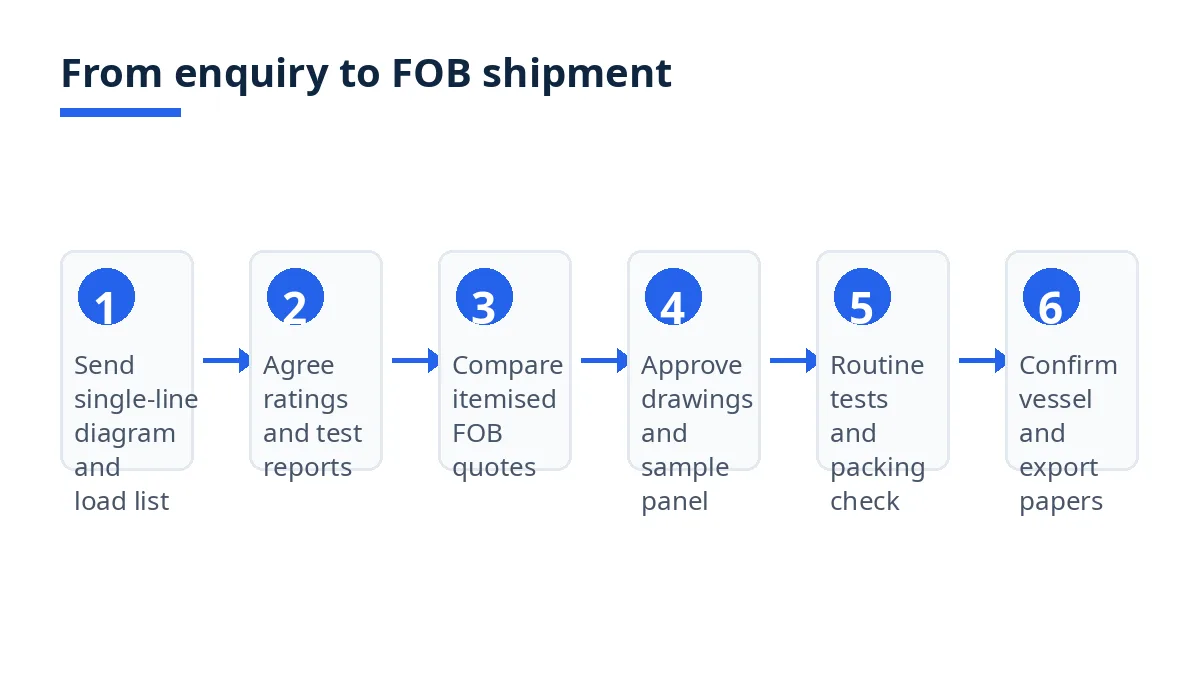

The diagram below sets out the sequence from enquiry to shipment. Each step produces a document you can keep.

Send one specification pack to every candidate. Include the single-line diagram, load list, rated voltage and current per feeder, short-circuit level, ingress protection, cable entry direction, and the standard part required. State whether you want a complete panel, loose devices, or both, with spares listed separately.
Ask for ratings and test evidence per model. For each breaker and assembly, ask for rated voltage, rated current, short-circuit breaking capacity, and the standard part tested to. Treat a rating stated without a test report reference as an open question, not a confirmed figure.
Ask for an itemised FOB quote. Require the cost lines in the table below, each on its own line, with the term written as FOB plus the named port, for example FOB Chattogram.
Approve drawings before manufacture. Ask for the general arrangement drawing, single-line diagram, and busbar layout, and approve them in writing. Late approval, after steel is cut and busbar ordered, is the usual source of rework charges.
Agree routine tests and witness points. Record which tests are routine, which reports you receive, and whether you or a third party witness any test. Keep the test plan in the purchase order.
Confirm packing, vessel, and papers together. Heavy panels need crating, bracing, and lifting points agreed before packing starts. Give the vessel name and loading point in time, because under FOB the buyer must inform the seller in time of the vessel name and loading point within the port.2 If that notice is late and the goods cannot be loaded, risk and added costs can pass to the buyer.2
Costs, timelines and documents
An FOB switchgear price is built from equipment, assembly, testing, packing, and origin transport. The table below gives the lines to demand.
Cost line | What it covers | What to check |
|---|---|---|
Breakers and switching devices | Incoming and outgoing breakers, switches | Frame, trip unit, poles, breaking capacity, test report |
Protection and metering | Relays, transformers, meters, indicators | Relay type, transformer ratios, accuracy class |
Busbar and internal wiring | Copper or aluminium busbar, supports, wiring | Material, cross-section, temperature-rise basis |
Enclosure and fabrication | Steelwork, doors, plinth, paint, glands | Dimensions, ingress protection, indoor or outdoor build |
Assembly and labour | Fitting, wiring, labelling, inspection | Included or charged apart |
Routine testing and documents | Routine tests, reports, drawings, manuals | Per panel or per batch, language, copies |
Packing and crating | Export crates, bracing, moisture protection | Seaworthy packing, lifting points, weight per crate |
Origin transport and export handling | Factory to port, port handling, loading | Named port, loading cost inside FOB figure |
Commercial charges | Banking, documentation, handling fees | Inside FOB price or separate |
Example figures: the table below is illustrative only, not a quote or a typical price. It shows how the lines add up for one low-voltage distribution board, per panel on FOB terms.
Cost line | Example figures, US$ per panel |
|---|---|
Breakers and switching devices | 6,200 |
Busbar and internal wiring | 2,800 |
Enclosure and fabrication | 2,400 |
Protection and metering | 1,900 |
Assembly and labour | 1,600 |
Routine testing and documents | 700 |
Packing, crating, and origin transport | 900 |
FOB price | 17,400 |
Read the example for structure, not for level: a larger breaker, higher rating, or outdoor enclosure moves several lines at once.
What are the typical costs and timelines?
There are no typical switchgear costs or timelines a guide can state as fact, because each assembly is priced for its ratings, device selection, quantity, and delivery term. Timelines depend on device availability, drawing approval, fabrication, testing, and vessel timing. Ask for separate dates for drawing approval, manufacture, testing, packing, and readiness at port, rather than a single delivery week.
Quantity changes the shape of the price. A first panel carries drawing, approval, and set-up work that a repeat panel does not, so ask whether the quoted price is for the first panel, for a batch, or for a repeat, and whether spares are priced per item or as a lot.
Which documents are needed?
For export clearance in Bangladesh, goods may not be loaded unless an export declaration, the Bill of Export or Shipping Bill, is submitted to Customs and approved.6 The enclosed documents include the export letter of credit, or where there is none the export contract or purchase order approved by the negotiating bank, the commercial invoice, the packing list, the EXP form certified by an authorized dealer, and a certificate of origin issued by the Export Promotion Bureau or a Chamber of Commerce and Industry.6
For switchgear, add the approved single-line diagram and general arrangement drawing, the itemised quotation, the purchase order stating ratings and the standard part, routine test reports, and the operation and maintenance manual. Keep the model, rating, and standard part identical across the quotation, invoice, packing list, test report, and export declaration. A mismatch between the test report rating and the invoice rating is a common reason for a buyer query at destination.
Bangladesh-specific rules and tips
Keep one legal name and one model description across every paper. The export declaration names the exporter and the foreign buyer,6 so the name on the trade licence, quotation, proforma invoice, and payment account should match.
Confirm imported devices early. Breakers, relays, and transformers in a Bangladeshi-assembled panel may be imported for your specification, and an imported device can set both the price and the earliest manufacture date. Ask which devices are stocked and which are ordered for your panel.
Agree the port and the loading point in the quotation. FOB Chattogram is not complete unless both parties know who pays each port handling charge inside the FOB figure. Write the named port, loading cost treatment, and vessel notice period into the purchase order.
Check the crate, not only the panel. A crate without bracing, lifting marks, or moisture protection can damage a tested assembly before it reaches the vessel. Ask for the packing specification and a photograph of the packed crate before dispatch.
Mistakes and red flags
What are the most common mistakes?
Comparing a panel price with a loose-device price. A board price includes enclosure, busbar, wiring, assembly, testing, and packing. A breaker price does not. Compare only quotations for the same scope, delivery term, and ratings.
Accepting a rating without a matching test report. A breaker frame, a busbar size, and an assembly rating each need their own evidence. A report for a larger frame does not prove the smaller frame, and a catalogue page does not replace a test report.
Leaving protection and metering out of the comparison. Two panels with the same incoming breaker can differ greatly in protection, metering, and transformer content. List those items line by line, or the cheaper panel wins by omission.
Agreeing the price before approving the drawings. A price agreed on a single-line diagram alone leaves enclosure size, cable entry, and busbar layout open. Approve the general arrangement drawing first, then confirm the price still covers the approved design.
Treating a profile or a badge as technical approval. A company profile shows that a business exists and sells switchgear. It does not test whether a panel meets your short-circuit level or site conditions. Drawing approval and routine test reports stay with you, whatever the profile says.
Naming FOB without naming the port and the vessel process. FOB without a named port, a loading cost treatment, and a vessel notice procedure is an incomplete term. Late vessel notice, a delayed vessel, or an early cargo closing can shift risk and storage cost to the buyer even before loading.2
Checklist
Before you accept a switchgear price, every line below should be answered in writing.
Scope stated: complete panel, loose devices, spares, or a combination, spares priced apart.
Single-line diagram, load list, and site conditions sent to every candidate.
Ratings confirmed per model: voltage, current, short-circuit capacity, standard part.4 5
Test report reference supplied for the exact model and rating quoted.
Itemised FOB quote received, with named port and loading cost treatment.
Drawings approved in writing before manufacture starts.
Routine tests, reports, and witness points written into the purchase order.
Packing agreed: crating, bracing, lifting points, gross weight per crate.
Export set agreed: invoice, packing list, EXP form, certificate of origin, Bill of Export.6
Vessel notice procedure agreed: who gives vessel name and loading point, and by when.2
Quotations compared on same scope, ratings, and delivery term only.
How Exportain helps
On Exportain, browse suppliers and post a request for quotation on the RFQ board with your single-line diagram summary, load list, ratings, and delivery term, so suppliers quote against the same specification. Ask each reply for its itemised FOB lines, per-model test report references, and packing specification. The electrical products sourcing guide sets out the same enquiry discipline for the wider electrical range.
Read the badges for what they record. Exportain verification is a document and photo review by staff, not a factory inspection, and membership plans never grant a trust badge.7 A badge does not confirm a short-circuit rating, a test result, or a delivery date, so drawing approval and routine test reports remain your controls.
FAQs
What should I know first about switchgear?
Switchgear controls, protects, and distributes electricity, and a panel price is a system price, not a device price. Before comparing prices, fix the scope, ratings, standard part, and delivery term. Assembled boards, panels, and cabinets fitted with two or more switching or protection devices fall under heading 8537, split at 1,000 volts.3
What are the typical costs and timelines?
There are no typical figures a buyer can rely on, because each assembly is priced for its ratings, device selection, quantity, and term. The cost lines are breakers, protection and metering, busbar and wiring, enclosure, assembly, testing, packing, and origin transport. Ask for each timeline stage as a separate date.
Which documents are needed?
The order documents are the approved drawings, itemised quotation, purchase order stating ratings and the standard part, routine test reports, and manual. The export set is the Bill of Export, commercial invoice, packing list, EXP form certified by an authorized dealer, and certificate of origin from the Export Promotion Bureau or a Chamber of Commerce and Industry.6
What are the most common mistakes?
The most common mistakes are comparing a panel price with a loose-device price, accepting a rating without a test report for the exact model, leaving protection and metering out of the comparison, and naming FOB without a named port and vessel notice procedure.2 A cheaper panel that omits a required function is not a lower price for the same goods.
Next steps on Exportain
Browse suppliers, then post your single-line diagram summary, load list, and ratings on the RFQ board so suppliers return itemised FOB quotations for the same panel. Before you confirm, read the electrical equipment exporter guide.
Sources
- Incoterms® 2020. International Chamber of Commerce (ICC) (accessed )
- FOB & FAS Incoterms® 2020 explained: Key differences. ICC Academy (accessed )
- Heading 8537: boards, panels, consoles, desks and cabinets. GOV.UK, HM Revenue and Customs (accessed )
- IEC 61439-2:2011 Low-voltage switchgear and controlgear assemblies - Part 2: Power switchgear and controlgear assemblies. International Electrotechnical Commission (accessed )
- SIST EN IEC 62271-212:2022 High-voltage switchgear and controlgear - Part 212: Compact Equipment Assembly for Distribution Substation (CEADS) for AC voltages up to 52 kV. International Electrotechnical Commission (accessed )
- Customs Clearance Procedures for Export. Bangladesh Customs, National Board of Revenue (accessed )
- Supplier verification: Earn trust badges buyers can see. Exportain (accessed )
About the author
