Refrigerators Lead Time From Bangladesh: Production and Shipping Timeline

Refrigerator lead time from Bangladesh, stage by stage: what moves the date, which documents to prepare, and how to protect your delivery week.

By Nourin Tabassum

Reviewed by Naim Islam

Published 12 min read

Short answer

There is no single refrigerator lead time from Bangladesh. The date depends on whether the model is stocked or built to your specification, on compressor and refrigerant availability, on sample and energy-label approval, and on inspection, export clearance and the next sailing. Get each stage as a dated line in writing, and plan from the last gate, not from the order date.

Navy title card: Refrigerators Lead Time From Bangladesh, production and shipping timeline
Exportain Buyer Guide: refrigerator lead time from Bangladesh, production and shipping timeline.Exportain

Key takeaways

  • There is no single refrigerator lead time from Bangladesh: stocked models, new-colour models and models with a different compressor, refrigerant, voltage, plug or energy class move on different timelines.

  • The clock usually starts at specification freeze and sample approval, or at the arrival of the last critical input, not at the enquiry or deposit date.

  • The gates that most often move the date are a post-sample compressor or refrigerant change, a destination label or test-data gap, a failed leak or performance test, and a missed sailing cut-off.

  • Use dated lines for sample approval, input arrival, testing, inspection, export clearance and sailing, and build buffers after the test gate and the inspection gate.

  • Prepare the export set while production runs: Bill of Export, commercial invoice, packing list, EXP form certified by an authorized dealer, and certificate of origin.

A refrigerator order from Bangladesh does not move on one clock. It moves through a chain of gates: the specification must be frozen, the sample approved, the compressor and refrigerant secured, the cabinet foamed and assembled, and the unit charged, tested and labelled, before inspection, export clearance and a sailing can be booked. A date quoted before those gates are checked is a hope, not a plan. All stage durations below are indicative planning ranges to confirm with your supplier in writing, not supplier quotes and not figures from a published source.

Refrigerators, freezers and other refrigerating equipment fall under heading 8418, which covers refrigerators, freezers and other refrigerating or freezing equipment, electric or other, and heat pumps other than air-conditioning machines of heading 8415.1 Household compression-type refrigerators sit in subheading 8418.21.1 Getting the classification right matters for the export papers, because the export declaration must name the goods, their value, the exporter, the foreign buyer and the transport operator.2

Why this matters for buyers and sellers

For a buyer, the lead time decides when stock arrives and how much working capital sits in goods in transit. A refrigerator is bulky and ships upright, so a late change to capacity or packaging costs more than a late change to a smaller product. For a seller, foam, steel, compressors and controls are sequenced for a batch, and a unit that fails a leak or performance test cannot simply be swapped for another model.

The most expensive misunderstanding is the start date. Buyers often count from the enquiry or the deposit; suppliers usually count from specification freeze and sample approval, or from the arrival of the last critical input. Agree in writing which event starts the clock, and write it into the purchase order.

What should I know first about refrigerators?

Know the model before you ask for a date. A stocked standard model, a standard model in a new colour or panel finish, and a model with a different compressor, refrigerant, voltage, plug or energy class are three different orders with three different timelines. The first may only need inspection and shipping; the third needs input sourcing, a performance test and a destination-market check before production can be scheduled at all.

State the full specification in the first enquiry: type, capacity, compressor type, refrigerant, voltage and plug, energy class for your market, colour and panel finish, door and handle details, shelving layout, and carton and pallet packing. A date quoted against an incomplete specification will be revised once the missing line is added, usually after you have already promised stock to your own customers.

Step-by-step: how it works

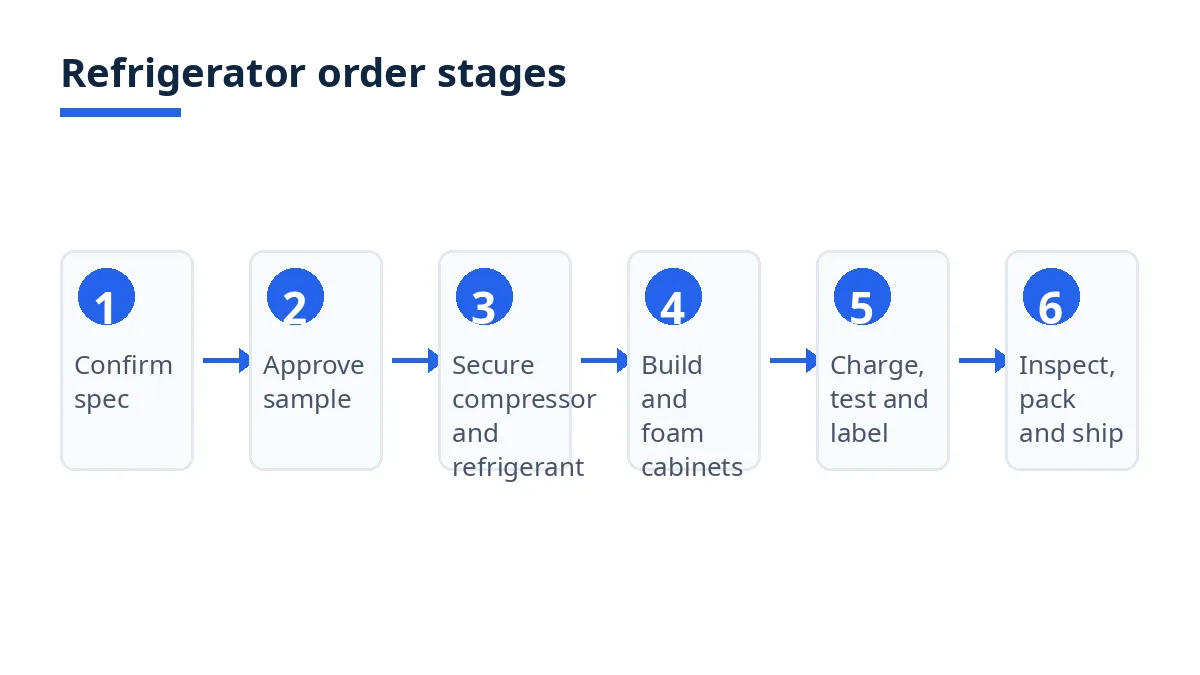

Diagram: six stages of a refrigerator order from Bangladesh, from spec approval to inspection and shipping
Six stages of a refrigerator order from Bangladesh, from spec approval to inspection and shipping.Exportain
  1. Freeze the specification and confirm the market rules. Write down the model, capacity, compressor, refrigerant, voltage, plug, energy class and labelling for the destination market. For the European Union, suppliers must ensure each refrigerating appliance has a printed label in the set format, and the product information sheet and technical documentation are uploaded into the product database.3 Confirm the label and test data for your exact model before production, not after packing.

  2. Approve the sample in writing. Order a sample in your actual colour, panel, plug and refrigerant configuration, check temperature performance, door seal, noise and finish, and approve it or list corrections in writing. Batch corrections into one list, since every round restarts part of the clock.

  3. Secure the long-lead inputs. Ask the supplier to confirm, in writing, which inputs are stocked and which must be ordered in: compressor, refrigerant, foam chemicals, steel or panels, evaporator and condenser parts, controls and door seals. Record the expected arrival date for each input that is not stocked, and agree what happens if it slips.

  4. Build, foam and assemble in batches. Ask for the batch size, the line schedule and the date the first finished units come off the line, not only the date the whole order finishes. Early units can be inspected while later units are still being assembled.

  5. Charge, leak-test and performance-test every unit. Agree the test standard, the test duration and what counts as a failure before production starts, and agree how failed units are repaired and retested without holding the passing units.

  6. Inspect, pack and prepare the export set. Agree the inspection plan before production ends. ISO 2859-1 defines a system of acceptance sampling plans for inspection by attributes, and its acceptance quality limit (AQL) is the maximum average percentage of defective items considered acceptable during random sampling.4 Add unit-level checks: temperature performance, door seal, finish, labelling, plug and carton marking. Pack upright and prepare the export documents while inspection is running, not after it.

  7. Clear export and book the sailing. Goods may not be loaded or stuffed into containers for export unless an export declaration, the Bill of Export or Shipping Bill, is submitted to Customs and approved.2 Book only after inspection and the export set are ready, and confirm the container plan, cut-off time and port of loading in writing.

The gates that move a refrigerator date most often are a refrigerant or compressor change after sampling, an energy-label or test-data gap found at packing, a failed leak or performance test on part of a batch, and a missed sailing cut-off because inspection finished a day late. Build a buffer after the test gate and after the inspection gate, not only at the end of the plan.

Costs, timelines and documents

What are the typical costs and timelines?

There are no typical costs a guide can state as fact for a refrigerator order, because the price moves with capacity, compressor type, refrigerant, energy class, voltage and plug variant, panel and colour, packing, inspection, and the delivery term you choose. The Incoterms 2020 rules give a clear allocation of cost, risk and obligations for each rule.5 Compare quotations only on the same rule and named place, for example FOB Chattogram, because a price on one rule contains a different journey from a price on another.

Use the indicative planning ranges below as structure for your own planning, to be replaced by dated lines from your supplier. Stages overlap: inputs can be ordered while the sample is being corrected, and packing can start while the last units are being tested. Do not add the top of every range together and call the total a lead time.

Stage

Indicative planning range

What to get in writing

Specification and sample approval

2–6 weeks

Frozen spec, sample approval date, correction round limit

Long-lead inputs (compressor, refrigerant, controls)

2–6 weeks if ordered at sample stage

Stocked or ordered, expected arrival per input

Cabinet, foaming and assembly

2–4 weeks per batch

Batch size, line dates, first-unit date

Charging, leak and performance testing

Within the production window, plus rework time

Test standard, failure rule, retest plan

Inspection, packing and export documents

1–2 weeks

Inspection date, AQL values, packing and marking spec

Port handling and sailing

Depends on sailing frequency and destination

Cut-off time, vessel, port of loading

As a planning shape only: a stocked standard model may move from order confirmation to sailing in weeks, while a custom model with an ordered-in compressor, a new panel and a destination label check may take several months from specification freeze to sailing. Treat any single-week promise for a custom model as a question until the supplier shows the dated line for each gate.

Which documents are needed?

For export clearance in Bangladesh, goods may not be loaded unless an export declaration, the Bill of Export or Shipping Bill, is submitted to Customs and approved.2 The documents enclosed with the Bill of Export for all export consignments include the export letter of credit, or the export contract or purchase order where there is no letter of credit, the commercial invoice, the packing list, the EXP form certified by an authorized dealer, and a certificate of origin issued by the EPB or a Chamber of Commerce and Industry.2 The set also includes the VAT registration certificate and the taxpayer identification number.2

Your order file should also hold the frozen specification, the written sample approval, the test and inspection plan with AQL values,4 the energy-label and product information data for the destination market,3 and the delivery term with its named place.5 For containers handed to a carrier at a terminal, the any-mode rules FCA, CPT or CIP often describe the handover more accurately than the sea-only rules.6

Bangladesh-specific rules and tips

Start the export set at the sample stage. The EXP form, the certificate of origin and the commercial invoice all carry names, values and descriptions that must match across every paper. A mismatch found at the port costs the sailing. Ask the supplier or clearing agent to draft the set while production is running.2

Confirm the refrigerant and the label for the destination, not only for Bangladesh. A model that sells in one market may need a different refrigerant, a different energy label or different test data in another. For the European Union, the supplier must provide the printed label and the electronic label and product information sheet for dealers, and dealers must display them, including in distance selling.3 If the label data is not ready, the units cannot be listed properly on arrival, however fast they shipped.

Plan the container around the product, not the other way round. Refrigerators ship upright, and the number that fits a container depends on unit dimensions and the packing plan. Ask for carton dimensions, units per container, the stacking rule and handling marks before you book freight, and confirm whether the price covers a full container or a shared load.

Keep one legal name and one model description across every paper. The export declaration names the exporter and the foreign buyer,2 so the name on the quotation, proforma invoice, packing list and payment account should match, and the model description should match on the invoice, packing list and Bill of Export.

Book the sailing after inspection, and keep a second sailing in view. Ask for the vessel schedule for two sailings, not one, and agree who pays for storage and rebooking if inspection or export clearance slips past the first cut-off.

Mistakes and red flags

What are the most common mistakes?

Counting from the enquiry date. The supplier's clock usually starts at specification freeze or sample approval, or at the arrival of the last critical input. A timeline counted from the enquiry will always look shorter than the timeline the factory is working to.

Changing the specification after sampling. A new compressor, refrigerant, panel colour or plug after sample approval is a new sample, a new test and often a new input order. Batch all changes before approval.

Accepting a single delivery week with no stage dates. A single week hides every gate. Ask for dated lines for sample approval, input arrival, testing, inspection, export clearance and sailing.

Comparing quotations on different delivery terms. The Incoterms 2020 rules allocate cost, risk and obligations differently for each rule.5 A lower price on one rule may simply contain less of the journey. Compare only replies to the same specification on the same rule and named place.

Skipping the performance test to save a week. A refrigerator that cools badly on arrival cannot be fixed by a discount. The leak and performance test is the last gate before the unit becomes your stock.4

Booking freight before inspection passes. Freight booked against an uninspected batch may need rebooking. Book after inspection and the export set are ready, or confirm the rebooking cost in advance.

Treating a profile or a badge as a delivery guarantee. A profile is a starting point for enquiries. It does not prove that a factory can build your model to your test standard on your dates. Sample approval and a dated production plan are the proof.

Checklist

  • Model frozen: type, capacity, compressor, refrigerant, voltage, plug, energy class, colour and panel.

  • Destination label and test data confirmed for your exact model.3

  • Sample approved in writing, with corrections batched into one list.

  • Long-lead inputs confirmed: stocked or ordered, with an arrival date per input.

  • Batch plan agreed: batch size, line dates, first finished unit date.

  • Test standard agreed: charging, leak test, performance test, failure and retest rule.

  • Inspection plan agreed: sampling plan, AQL values, unit-level checks.4

  • Packing agreed: upright cartons, units per container, stacking rule, handling marks.

  • Export set drafted: invoice, packing list, EXP form, certificate of origin, Bill of Export.2

  • Delivery term agreed: one Incoterm and named place on every quotation.5

  • Sailing plan agreed: cut-off time, vessel, second sailing in view, rebooking cost.

How Exportain helps

On Exportain, browse suppliers and post a request for quotation (RFQ) on the RFQ board with your frozen specification, destination market and delivery term, so suppliers quote against the same model and journey. Ask each reply for dated lines for sample approval, input arrival, testing, inspection and sailing, not a single delivery week.

For the neighbouring steps, read how to import refrigerators from Bangladesh, the refrigerators quality control checklist and the HS code for refrigerators guide.

FAQs

What should I know first about refrigerators?

Know the model before you ask for a date. A stocked model, a model in a new colour or panel, and a model with a different compressor, refrigerant, voltage, plug or energy class have different timelines, because the third needs input sourcing and a destination-market check first. Refrigerators fall under heading 8418, with household compression-type models in 8418.21.1

What are the typical costs and timelines?

There are no typical costs a guide can state as fact: capacity, compressor, refrigerant, energy class, packing, inspection and the delivery term all move the price.5 For timelines, use the stage table as indicative planning ranges only, and replace each range with a dated line from your supplier.

Which documents are needed?

The order documents are the frozen specification, the written sample approval, the test and inspection plan, and the delivery term with its named place.5 4 The export set is the Bill of Export, commercial invoice, packing list, EXP form certified by an authorized dealer, and certificate of origin issued by the EPB or a Chamber of Commerce and Industry.2

What are the most common mistakes?

The most common mistakes are counting from the enquiry date instead of specification freeze or sample approval, changing the specification after sampling, accepting a single delivery week with no stage dates, comparing quotations on different delivery terms,5 and booking freight before inspection passes.

Next steps on Exportain

Browse suppliers, then post your frozen specification and delivery term on the RFQ board so suppliers reply with dated stage lines instead of a single week. Before you confirm, read how to import refrigerators from Bangladesh and the Incoterms guide.

Sources

  1. Refrigerators, freezers and other refrigerating or freezing equipment, electric or other; heat pumps other than air-conditioning machines of heading 8415 - UK Integrated Online Tariff. GOV.UK (accessed )
  2. Customs Clearance Procedures for Export. Bangladesh Customs, National Board of Revenue (accessed )
  3. Ecodesign and energy labelling requirements — household refrigerators: Regulation (EU) 2019/2019 and Delegated Regulation (EU) 2019/2016. European Union (accessed )
  4. ISO 2859-1:2026 - Sampling procedures for inspection by attributes — Part 1: Sampling schemes indexed by acceptance quality limit (AQL) for lot-by-lot inspection. ISO (accessed )
  5. Incoterms® 2020. International Chamber of Commerce (ICC) (accessed )
  6. Incoterms for Shipments From Bangladesh. Exportain (accessed )
