Workwear and Uniforms Lead Time From Bangladesh: Production and Shipping Timeline

Workwear and uniforms lead time guide from Bangladesh: durable-fabric, reflective trim, full-size-range fit, branding, reinforcement, wash durability, and colour consistency gates, with a navy warehouse crew set worked example.

By Naim Islam

Reviewed by Nourin Tabassum

Published 11 min read

Short answer

A workwear and uniforms lead time from Bangladesh runs on approval gates, not a single production run: durable-fabric approval, reflective trim, fit across the full size range, logo and branding, pocket and closure reinforcement, wash durability, and colour consistency across the set, then bulk sewing, inspection, and export documents. Every duration and figure is an illustrative planning example only. Replace it with the written quote and the dated forwarder estimate before setting a selling date.

Navy title card: Workwear and Uniforms Lead Time From Bangladesh
Exportain Buyer Guide: workwear and uniforms lead time from Bangladesh.Exportain

Key takeaways

  • Durable-fabric approval comes before cutting: a new lot reopens the gate, because a jacket and trouser cut from different lots may not read as one uniform set.

  • Reflective trim is a buyer-specification item checked on the full set worn together, since trim that looks clear on a flat garment can disappear under a jacket or a bent sleeve.

  • Fit is approved across the full size range, not on one middle size, with a measurement table for every size and samples that can be walked, bent, and reached in.

  • Logo and branding, pocket and closure reinforcement, wash durability, and colour consistency are each approved in writing on a finished or washed sample before bulk starts.

  • Every duration and cost figure is an illustrative planning example only, and the selling date must be set from the written quote and the dated forwarder estimate, not from this guide.

A uniform only works when it is worn as a set. A jacket that matches its trouser on a hanger can still fail on a shift, when the jacket covers the trim, the logo sits across a seam, or the pieces no longer look like one uniform after washing. A workwear order from Bangladesh is therefore best planned as a sequence of approvals, not as a single production run with a delivery date attached at the end.

A gate is a named approval, sample, or document that must close before the next stage starts. Every duration and cost figure here is an illustrative planning example only, or an item to confirm in the written quote and the dated forwarder estimate. No figure here is a promise for any real order. Replace every example figure with the written quote and the dated forwarder estimate before setting a selling date.

Why this matters for buyers and sellers

For a buyer, the risk sits in parts that must agree across pieces, sizes, and washes. Bangladesh garment production is described in one manufacturing guide as a chain from buyer inquiry and tech pack review through fabric sourcing, sampling, cutting, sewing, quality control, finishing, packing, and export shipment, with workwear and uniforms named among the products sourced from Bangladesh.1 A workwear set adds its own links to that chain, because trim, branding, reinforcement, fit, and colour must be approved on the finished set.

One European market guide notes that buyers may add specific requirements for wash behaviour, shape retention, colourfastness, and durability of trims such as zippers, buttons, and reflective details.2 Treat each as a buyer specification to confirm in writing for your market.

Step-by-step: how it works

Read the order against seven gates, then bulk, inspection, and documents.

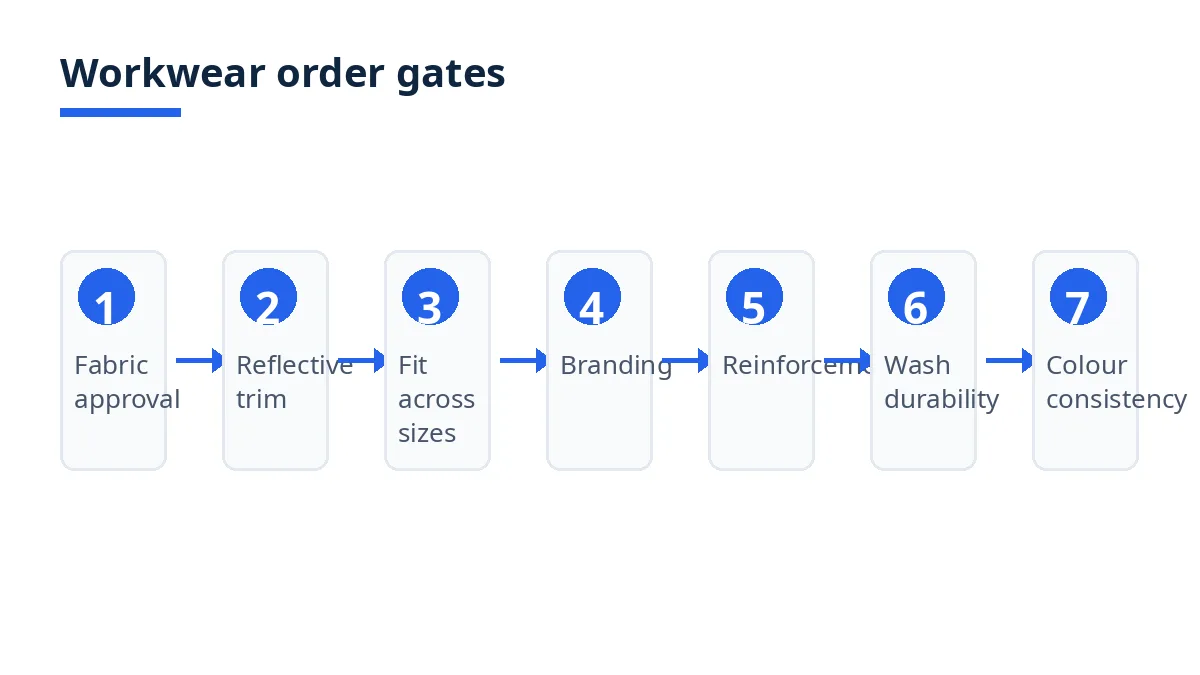

Workwear order gates diagram: fabric, trim, fit, branding, reinforcement, wash durability and colour consistency
Workwear order gates, from fabric approval to colour consistency across the set.Exportain

Gate 0: Durable-fabric approval

Gate 0 fixes the workwear fabric before cutting. The buyer specification should name the fabric type, fibre composition where specified, shade reference, width, and cutting lot. A manufacturing guide notes that a manufacturer should confirm fabric composition, shrinkage, colour fastness, hand feel, stretch, and durability before bulk.1 Ask the seller to confirm in writing whether the fabric is in stock, is to be dyed or finished for this order, or is to be woven for this order, and which shade lot each piece and size will be cut from. A new lot reopens Gate 0, because a jacket and trouser from different lots may not read as one set.

Gate 1: Reflective trim as a buyer-specification item

Gate 1 approves reflective trim as a buyer-specification item, not a factory default, naming trim type, placement on each piece, attachment method, and how it will be checked on a worn set. One custom workwear guide notes that high-visibility garments need reflective coverage visible from multiple angles.3 Check trim on a worn set, not on a flat garment: a strip that looks clear on a table can disappear when a jacket is worn over a trouser or a sleeve is bent. Approve positions with the full set worn together, record them from fixed points such as a hem or seam, and confirm trim durability and cleaning method in writing. If trim type, placement, or attachment changes, Gate 1 reopens.

Gate 2: Uniform sizing and fit approval across the full size range

Gate 2 approves fit across the full size range, not on one middle size, with a fit or measured sample for each main size group, a measurement table for every size, and the tolerance at each point of measure. One custom workwear guide advises using employee measurements, sample fittings, and a documented size chart before bulk production, and reviewing at least one sample per main size group.3 Check jacket and sleeve length, trouser waist and inseam, and how the pieces sit together, at each size group, on samples that can be walked, bent, and reached in. If pattern, grading, or size range changes, Gate 2 reopens.

Gate 3: Logo, embroidery, and branding approval

Gate 3 approves logo, embroidery, and branding as a controlled specification, not decoration added after garment selection. The same guide notes that customisation should be planned as a controlled specification, and lists embroidery, screen printing, heat transfer, patches, woven labels, and printed labels among the methods, each affecting durability, wash performance, and hand feel.3 A Gate 3 approval should name the method for each position, artwork version, placement from fixed points, and thread or print colour reference. Check branding on the finished garment, on the seam and pocket positions it will actually sit on, since a logo across a pocket seam or trim strip behaves differently from the same logo on flat fabric. Where a garment carries reflective trim or a protective function, confirm in writing that branding does not cover trim or alter the agreed specification. If method, artwork, placement, or colour changes, Gate 3 reopens.

Gate 4: Pocket and closure reinforcement

Gate 4 records pocket and closure reinforcement as a buyer-specification item. Workwear pockets carry tools and daily items, and closures are used far more often than on a fashion garment, so both need a written list rather than a general claim of strength. A Gate 4 approval should name each pocket, its position, closure type, and reinforcement, and each closure on the set, with reinforcement at each stress point shown on a finished sample. Check pockets by loading them and closures by opening and closing them on the sample, and approve reinforcement on the same fabric and trim combination as bulk. If a pocket, closure, or reinforcement changes, Gate 4 reopens.

Gate 5: Wash durability as a buyer-specification item

Gate 5 approves wash durability as a buyer-specification item, with cleaning method and sample evidence agreed in writing before bulk. A Gate 5 approval should name the laundering method, the sample pieces to be washed, and what will be checked after washing: shade, trim appearance and attachment, branding, pocket and closure function, shrinkage and shape, and whether the pieces still match as a set. Wash the set together, since pieces washed separately can hide a shade or shrinkage difference. Do not approve wash durability from an unworn sample. If fabric, trim, branding, or cleaning method changes, Gate 5 reopens.

Gate 6: Colour consistency across uniform sets

Gate 6 approves colour consistency across the whole set, across sizes, and across lots, naming the colour reference for each piece, the approved lab dip or shade sample where specified, and the cutting lot for each piece. One custom workwear guide advises using controlled colour references such as an approved lab dip to reduce variation across garments and batches.3 Check the set under the same light, worn together, and again after washing, at Gate 5, since a set that matches before washing can drift apart if one piece shifts more. If colour reference, dye lot, or fabric lot changes, Gate 6 reopens.

Bulk sewing, inspection, and documents

Bulk sewing should add no new decisions. Cutting follows Gate 0, trim follows Gate 1, fit follows Gate 2, branding follows Gate 3, reinforcement follows Gate 4, and the washed and colour-checked set from Gates 5 and 6 is the standard bulk must match. In-line checks should compare finished pieces against approved samples at each stage, rather than waiting for a final check to catch a fault that has already run through the full order.

One workwear sourcing guide describes quality checks at three stages: fabric inspection before cutting, in-line audits during bulk, and a final random inspection before shipment.4 A manufacturing guide lists the same stages plus trims, cutting, measurement, finishing, and carton checks.1

Documents gate loading, so the document set must be ready before a ship date is promised. A DHL export guide for garments from Bangladesh lists commercial invoices, packing lists, bill of lading or air waybills, export declaration forms, and certificates of origin, and notes labels should carry size, material composition, care instructions, and country of origin.5

Costs, timelines and documents

The table below is an illustrative planning example only. Replace every figure with the written quote and the dated forwarder estimate for the real order.

Stage

Illustrative planning example

Confirm in the written quote

Fabric, trim, and set approvals

Example planning allowance of 5 weeks from tech pack to approved washed set

Fabric availability, trim route, and sample courier

Fit, branding, and reinforcement approvals

Example planning allowance of 3 weeks of sample rounds after the first set

Sample rounds included, and what each round costs

Bulk sewing and finishing

Example planning allowance of 5 weeks for the bulk run in the example

Line capacity, and the in-line check schedule

Inspection, labelling, and documents

Example planning allowance of 1 week before the booked loading date

Inspection booking, and the full document list

Sample courier in the example

Example figure of USD 95 per courier parcel

Courier route, and who pays per round

Forwarder estimate in the example

Example figure of USD 1,250 for the sea freight leg in the example

Dated forwarder estimate, named places, and delivery rule

A worked example shows why the gates matter: A navy warehouse crew set reached its second sample round with three faults: trouser-leg trim sat behind the jacket hem when the jacket was worn untucked, the chest logo distorted where it crossed the pocket seam, and the jacket shade read darker than the trouser after washing together. The trim was moved to stay visible, the logo was moved off the seam, and the shade was re-approved as a washed set. Bulk then matched the re-approved set.

Costs in a real order depend on the fabric and trim routes, the number of sample rounds, the branding method, the inspection scope, the document set, and the delivery rule. Price every quote to the same point before comparing two quotes. One European market guide notes that with FOB, the buyer becomes responsible for the goods once the seller has delivered them to the vessel.2

Bangladesh-specific rules and tips

Keep one dated version of the approved tech pack, measurement table, sample comments, trim positions, branding artwork, and allowed differences as the production and inspection reference, so a later sample round cannot silently replace an earlier approval. Record market-specific labelling or performance wording as a buyer specification at the relevant gate, not as a packing correction.

Confirm the delivery rule and the named places in the contract in writing. Treat shade lots as a scheduling item: when pieces or repeat sets are cut from different lots, Gate 0 and Gate 6 must both be re-approved, even if the fabric name is unchanged. The same applies to trim and thread lots.

Mistakes and red flags

  • Approving trim on a flat garment without checking the full set worn together.

  • Approving fit on one middle size, leaving the smallest and largest sizes to grading.

  • Placing a logo across a seam, closure, or trim strip without a finished-sample check.

  • Leaving pocket and closure reinforcement to a general claim, without a written list and loaded sample.

  • Approving wash durability from an unworn sample, or washing pieces separately.

  • Approving colour on single pieces instead of on the set worn together, before and after washing.

  • Promising a selling date from example figures instead of from the written quote and dated forwarder estimate.

  • Booking loading before the document set is ready.

Checklist

  • Durable fabric, shade reference, width, and cutting lot approved at Gate 0.

  • Reflective trim type, placement, attachment, and worn-set visibility at Gate 1.

  • Fit and measurement table approved across the full size range, including movement, at Gate 2.

  • Branding method, artwork version, placement, and colour reference on a finished sample at Gate 3.

  • Pocket and closure reinforcement list shown on a loaded, finished sample at Gate 4.

  • Wash durability approved on a set washed together, under the agreed cleaning method, at Gate 5.

  • Colour consistency across the set, across lots, and after washing, at Gate 6.

  • Bulk sewing checked in line against approved samples, with inspection booked before loading.

  • Commercial invoice, packing list, certificate of origin, transport document, and export declaration confirmed.

  • Written quote and dated forwarder estimate received; selling date set from those documents, not example figures.

How Exportain helps

Exportain lists suppliers buyers can review, and buyers can post a sourcing requirement and compare quotations against the gates in this guide. Use the gates as a checklist in your requirement, naming fabric, trim positions, size range, branding method, reinforcement list, washing method, and colour reference.

FAQs

What should I know first about workwear and uniforms?

Know the gates before the dates. A workwear order turns on durable-fabric approval, reflective trim, fit across the full size range, branding approval, pocket and closure reinforcement, wash durability, and colour consistency, each needing written approval on a sample.

What are the typical costs and timelines?

Use the illustrative planning example in the costs table above as a starting point only, and replace every figure with the written quote and the dated forwarder estimate. Costs depend on the fabric and trim routes, sample rounds, branding method, inspection scope, document set, and delivery rule, and timelines depend on which gates are already closed when the order is placed. No figure here is a promise for any real order.

Which documents are needed?

Confirm the document set in the written quote, and check it against the destination market before loading is booked. The core set in the export guides cited here includes the commercial invoice, the packing list, the certificate of origin, the transport document for the agreed mode, and the export declaration form, plus labels carrying size, material composition, care instructions, and country of origin.5 Record market-specific wording as a buyer specification at the relevant gate, not during packing.

What are the most common mistakes?

The most common mistakes are approving trim, branding, or colour on single pieces instead of on the worn set, approving fit on one size instead of across the range, accepting a general claim of reinforcement or washability without a sample, and setting a selling date from example figures instead of from the written quote and the dated forwarder estimate.

Next steps on Exportain

Sources

  1. Inside Bangladesh Garment Manufacturing Process. Minmax Textile (accessed )
  2. Entering the European market for workwear. CBI (accessed )
  3. Custom Workwear Solutions for Different Industries. Yingtong Textile (accessed )
  4. Workwear Sourcing & Manufacturing FAQ. Bengal Apparel BD (accessed )
  5. How to export garments overseas from Bangladesh. DHL (accessed )

About the author

Sourcing from Bangladesh?

Post a request for quotation and suppliers on Exportain can send you their quotes directly.

Post an RFQ
