Tank Tops Lead Time From Bangladesh: Production and Shipping Timeline
Tank tops lead time from Bangladesh: gated stages, knit, ribbing, strap width, print placement and size-curve approvals, plus a planning table and checklist for buyers.
Short answer
A tank tops lead time from Bangladesh is a chain of gated approvals, not a single figure. Lightweight knit, armhole and neckline ribbing, strap-width consistency, print placement on a small panel and a size curve across a wide range must close in writing before bulk sewing, and labelling, market-specific documentation, inspection and export clearance must close before loading. Every duration is a planning example or a dated quotation figure.

On this page
Key takeaways
A tank tops lead time is a chain of gated approvals, not a single figure: lightweight knit, armhole and neckline ribbing, strap-width consistency, print placement on a small panel and a size curve across a wide range close in writing before bulk sewing.
The tank-top-specific gates are lightweight jersey or rib knit approval as a separate stage, armhole and neckline ribbing approval on a finished sample, strap-width consistency measured the same way on every size, print placement approval on a small garment panel, and size-curve approval across a wide range.
Wash-care labelling and market-specific documentation are stage gates inside bulk sewing: the label must match the approved composition, and documentation for the destination market must be confirmed in writing, including items for trims and prints where the style includes them.
Inspection and export clearance close before loading, and transit is read only from a dated forwarder estimate for the exact route and port pair.
Compare supplier replies on the same gate table, the same tech pack and the same delivery term, working backward from the on-sale date with a buffer after inspection.
A tank top is judged at the shoulder, the armhole and the neckline, not in the body of the garment. A strap that twists, an armhole that gaps, a neckline rib that rolls, or a print that lands off centre on a narrow front panel will be noticed at once. A tank top that passes on one size, one colour or one strap width does not prove the rest of the order. Replace every planning figure here with the dated figures in the written quotation and forwarder estimate for the actual order.
Tank tops add gates where timetables slip most often: lightweight knit approval, ribbing approval, strap-width consistency, print placement on a small panel, size-curve approval, and wash-care labelling as a buyer-specification item. Skipping an approval moves the failure later, when correction means re-cutting or re-sewing.
Why this matters for buyers and sellers
For a buyer, the tank top timetable decides whether a complete range reaches the shelf with every strap, rib and print in the same place. A range that arrives with one colour still in knit approval, one size still in fit correction, or prints at different heights across colours is not a complete delivery, even if most cartons have arrived. Working backward from the on-sale date, with a buffer after inspection, protects the range.
The Bangladesh Knitwear Manufacturers and Exporters Association (BKMEA), established in 1996, is the apex trade body for the knitwear sector and represents approximately 2,540 knitwear member factories.1
Step-by-step: how it works

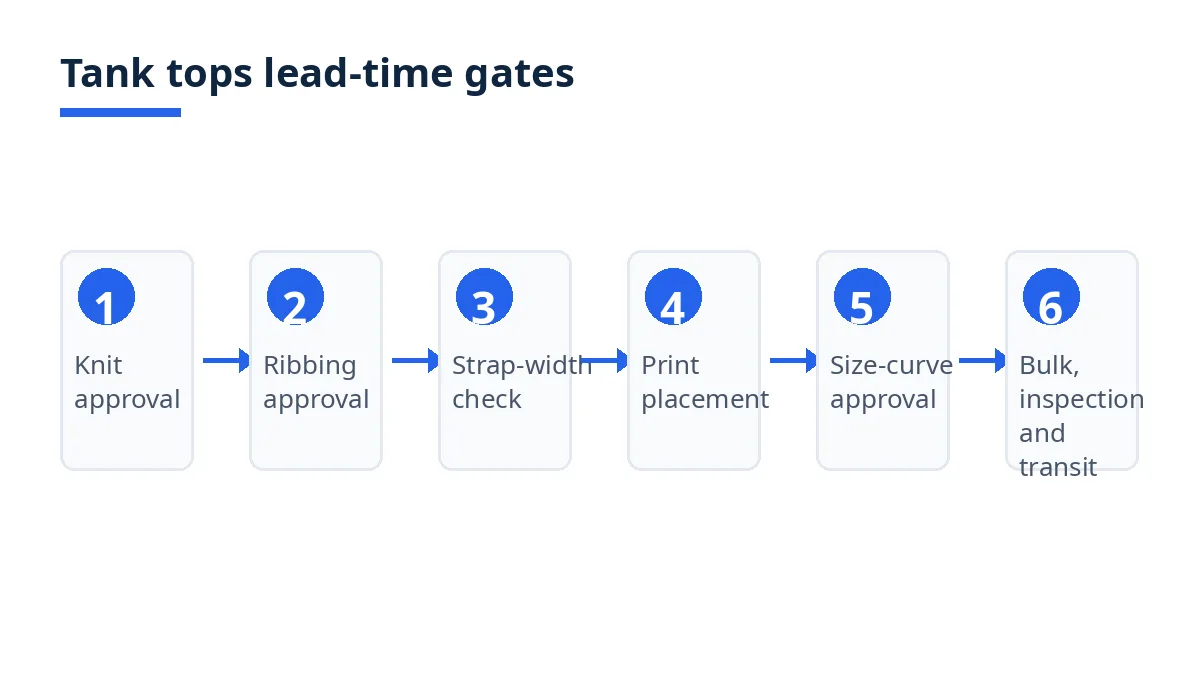

Read any supplier timeline against seven gates: knit, ribbing, strap width, print, size curve, bulk sewing with labelling, and inspection and clearance with transit. If a reply skips a gate, ask where that approval sits. A gate closes only by written approval naming what it covers.

Close the knit gate first: lightweight jersey or rib approval as a separate stage. State the fabric in the tech pack as a buyer specification: fibre composition, fabric construction and colour reference for each colour. Approve the knit on a washed fabric sample and a cut sample for each colour, recording the fabric lot covered. A sample cut from stocked fabric does not prove a later lot will match after washing, so bulk approval is a separate written step. If one colour is rejected, only that colour returns.
Close the ribbing gate: armhole and neckline ribbing on the garment itself. Approve the ribbing in the tech pack: rib construction, rib width, finished measurement at the neckline and at each armhole, and the joining method. Approve it on a finished sample worn or on a form, after the agreed wash check, recording the rib lot and sample size. Ribbing checked only laid flat does not prove it will lie flat in wear. If one opening is rejected, only that opening returns.
Close the strap-width gate: one width, measured the same way, on every size. Approve strap width as a buyer specification: the finished width at the shoulder, the measurement point, the tolerance, and the twist check after washing. Approve it on samples across the size range, not on a single middle size, because a strap that reads correctly on one size can read narrow or wide on another. Record the width per size, with photographs of the strap flat and on a form.
Close the print gate: placement on a small panel, not on paper. Approve print in the tech pack: artwork, placement measured from the neckline and armhole, print colours, and the area covered. Approve it on a physical sample of the actual tank top fabric, after the agreed wash check, recording the artwork version covered. A small front panel leaves little room for drift, so a print approved on paper or another garment does not prove it will sit centred here. If the artwork is rejected, only that artwork returns.
Close the size-curve gate: a wide range, checked size by size. Approve the size curve as a buyer specification: the full size range, with body length, chest, armhole depth, neckline depth and strap width recorded per size, with measurements against tolerance and photographs worn or on a form. A curve that passes at the middle can fail at the smallest or largest size, where strap width and armhole depth change the fit most. A size that measures correctly laid flat can still gap at the armhole in wear.
Run bulk sewing only after the five approvals above are in writing, and close labelling inside this stage. Sewing follows the approved fabric lots, ribbing, strap width, artwork and pattern. Wash-care labelling sits inside this stage as a buyer-specification item: fibre composition, care instructions and label placement, agreed before bulk labelling, so the label matches the approved composition. Regulation (EU) No 1007/2011 governs fibre names and labelling.2 Market-specific documentation is a separate stage gate here: confirm in writing, for the destination market, which documentation applies, including items for trims and prints where the style includes them. No item is settled until the written confirmation names the item and the document covering it. Any change after approval reopens its gate.
Inspect against the approved standard, then clear for export, and move the goods on a dated forwarder estimate. Agree the inspection plan before production starts: sampling plan, acceptance numbers, and correction and re-inspection window. ISO 2859-1 defines acceptance sampling plans for inspection by attributes, indexed by acceptance quality limit (AQL), and AQL is the maximum average percentage of defective items considered acceptable during random sampling.3 Inspection checks the tank top as worn: knit and shade per colour, ribbing lying flat, strap width per size with no twist, print centred, size curve per size, and wash-care label against the approved composition. Loading waits for the written report plus the export set. Transit starts when inspected goods are handed to the carrier and ends at the buyer warehouse, cleared for import. Ask the forwarder for a dated estimate for the exact route and port pair, naming sailing, transhipment, congestion and destination clearance variables, and what happens if the booked sailing is missed. The Incoterms 2020 rules allocate cost, risk and obligations across 11 rules.4 Write the rule, named place and edition together, for example FCA Chattogram, Incoterms 2020.
Costs, timelines and documents
Reading costs and timelines
There is no figure in this guide that can be used as a price or a delivery date for an actual order. Costs move with fabric, colour count, ribbing, strap specification, print, size range, labelling, documentation, inspection and delivery term, and the timetable moves with approval rounds, fabric lots, rib runs, print runs, line allocation, inspection results and the forwarder estimate. The table below is a planning example only; every cell must be replaced by the dated figures in the written quotation.
Gate | Illustrative planning example only | What closes the gate |
|---|---|---|
Lightweight jersey or rib knit approval | Two approval rounds | Written approval per colour, naming the fabric lot |
Armhole and neckline ribbing approval | One fitting check on a finished sample | Written approval of rib width and finished opening measurements |
Strap-width consistency approval | One measurement check across the size range | Written width per size, with measurement point and photographs |
Print placement approval | One approval round on the garment fabric | Written approval of artwork version, placement and print colour |
Size-curve approval across a wide range | One wear or form check across the size range | Written result per size, with measurements and photographs |
Bulk sewing, labelling and market-specific documentation | Written progress blocks, counting pieces cut, printed and sewn | Written progress, label and documentation agreed before bulk labelling |
Inspection, correction and export clearance | A correction and re-inspection window before loading | Written inspection report plus the export set |
Transit and import clearance | Dated forwarder estimate only, for the exact route and port pair | Dated estimate naming sailing and clearance variables |
Example figures: one adult tank top in four colours, ribbed neckline and armholes, a narrow strap, a small front print, and a size range from extra-small to extra-extra-large. In the worked example, knit comes before ribbing, strap width after ribbing, print after strap width, size curve after print, and bulk sewing only after all five approvals are in writing, with labelling and documentation agreed inside the bulk stage. If knit rejects one colour, only that colour returns. If ribbing rejects one opening, only that opening returns. If print rejects the placement, only that placement returns. If fit rejects one size, only that size returns. The example shows sequencing only, not a price, a delivery date or a promise about any supplier or order.
Which documents are needed?
The order documents are the tech pack, itemized quotation and purchase order, with fabric, colour references, ribbing, strap width, artwork, size range, wash-care label and named documentation items on all three. The inspection report, fabric lot approvals, ribbing approval, strap-width record, print approval and size-check record sit with the purchase order as evidence that each gate closed. For classification, heading 6109 covers T-shirts, singlets and other vests, knitted or crocheted, with subheadings by cotton and by other textile materials; confirm the entry for the actual fibre, construction and style with the destination customs rules before filing.5
For export clearance in Bangladesh, goods may not be loaded unless an export declaration, the Bill of Export or Shipping Bill, is submitted to Customs and approved.6 Enclosed documents include the export contract or purchase order where there is no export letter of credit, the commercial invoice, the packing list, the EXP form certified by an authorized dealer, and a certificate of origin issued by the EPB or a Chamber of Commerce and Industry.6
Bangladesh-specific rules and tips
Confirm the fabric route before approving the pre-production sample: a sample cut from stocked fabric does not prove a new bulk lot will match after washing. Confirm who handles export clearance and which agent is named, because the Bill of Export and EXP form must be approved before loading, and a late document is a missed sailing even when goods are ready.6
Mistakes and red flags
What are the most common mistakes?
Approving bulk from a photograph of a sample. A photograph cannot show whether ribbing lies flat after washing, whether a strap twists, whether an armhole gaps in wear, or whether a print sits centred on a small panel. Physical review across the size range remains the safer approval.
Treating a single total as a plan. A reply giving only a number of weeks, with no gate dates, approval points or correction route, cannot be managed. Ask for the gate table, and treat the order as unplanned until it arrives. A timetable listing knit, ribbing, strap, print and fit approval all starting the same day usually means the gates were not sequenced.
Accepting a bare knit, ribbing or print claim. Knit, ribbing and print are buyer-specification items, not adjectives. If the reply states no fabric lot, no rib width, no strap measurement point, no artwork version and no placement measurement, the claim is unapproved. Name those items, and require the report.
Checklist
Tech pack complete: fabric, colour references, ribbing, strap width, artwork, size range, wash-care label and documentation items.
Knit gate closed: fabric and shade approved per colour, lot named.
Ribbing gate closed: neckline and armhole rib approved, widths and measurements recorded.
Strap-width gate closed: width approved per size, measurement point recorded.
Print gate closed: artwork version, placement and colour approved on the garment fabric.
Size-curve gate closed: size curve approved per size, with measurements and photographs.
Labelling and documentation gate closed: label agreed, documentation confirmed in writing.
Production reporting agreed: written counts of pieces cut, printed, sewn and labelled.
Inspection agreed: sampling plan, acceptance numbers, correction and re-inspection window, tank top checks recorded.3
Documents prepared during production: draft invoice and packing list checked against the report, export set listed, agent named.6
Delivery term written in full: rule, named place and edition, for example FCA Chattogram, Incoterms 2020.4
Transit estimated by the forwarder: dated estimate for the exact route and port pair.
How Exportain helps
On Exportain, browse suppliers and post a request for quotation with your tech pack summary, fabric, ribbing, strap width, print artwork, size range and delivery term. Ask each reply for its gate dates in writing, and keep the accepted gate table with the purchase order.
FAQs
What should I know first about tank tops?
A tank tops lead time from Bangladesh is a chain of gated stages, not a single number. Lightweight knit, ribbing, strap width, print placement on a small panel and a size curve across a wide range must all close in writing before bulk sewing, and labelling, documentation, inspection and export clearance must close before loading. The gates that matter most are the washed knit lot per colour, the ribbing on a finished sample, the strap width per size, the print placement measured from the neckline and armhole, and the fit per size.
What are the typical costs and timelines?
There is no single figure that fits every tank tops order, so treat any single number with caution and ask for the order-specific version. Costs move with fabric, colour count, ribbing, strap specification, print, size range, labelling, documentation, inspection and delivery term,4 and the timetable moves with approval rounds, fabric lots, rib runs, print runs, line allocation, inspection results and the forwarder estimate. Use the planning example only to lay out the gates, then replace every cell with the dated quotation figures.
Which documents are needed?
The order documents are the tech pack, itemized quotation and purchase order, with fabric, colour references, ribbing, strap width, artwork, size range, wash-care label and named documentation items on all three, plus fabric lot approvals, ribbing approval, strap-width record, print approval, size-check record and inspection report. The export set is the Bill of Export, commercial invoice, packing list, EXP form certified by an authorized dealer, and a certificate of origin issued by the EPB or a Chamber of Commerce and Industry.6
What are the most common mistakes?
The most common mistakes are approving bulk from a photograph, treating a single total as a plan, accepting a bare knit, ribbing or print claim with no fabric lot, rib width, strap measurement point, artwork version or placement measurement,3 booking freight before inspection passes, and comparing quotations on different fabrics or terms.4
Next steps on Exportain
Browse suppliers, then post your tech pack summary, fabric, ribbing, strap width, print artwork, size range and delivery term on the RFQ board so suppliers state gate dates in writing. Before fixing the delivery term, read the Incoterms for shipments from Bangladesh guide.
Sources
- BKMEA at a Glance. BKMEA (accessed )
- Regulation (EU) No 1007/2011 on textile fibre names and related labelling and marking of the fibre composition of textile products. European Union, (accessed )
- ISO 2859-1:2026 - Sampling procedures for inspection by attributes — Part 1: Sampling schemes indexed by acceptance quality limit (AQL) for lot-by-lot inspection. ISO (accessed )
- Incoterms® 2020. International Chamber of Commerce (ICC) (accessed )
- Classification Detail — HS Code 6109. United Nations Statistics Division (accessed )
- Customs Clearance Procedures for Export. Bangladesh Customs, National Board of Revenue (accessed )
