Hoodies and Sweatshirts Lead Time From Bangladesh: Production and Shipping Timeline
How to read a hoodies and sweatshirts lead time from Bangladesh: fleece knitting, brushing, dyeing, hood and pocket work, decoration approval, inspection and transit as dated stages, with a stage table, document checks and red flags to check before ordering.
Short answer
A hoodies and sweatshirts lead time from Bangladesh is a chain of dated stages: sampling and hood approval, fleece knitting, brushing, dyeing, cut-and-sew, print or embroidery approval, inspection, and transit. No single figure fits every order. Ask each supplier for dated stages, named approvals, a correction route, and a forwarder estimate, then work backward from your selling date with a buffer after inspection.

On this page
Key takeaways
A hoodies and sweatshirts lead time is a chain of dated stages, not a single number, with extra gates for fleece knitting, brushing, dyeing, hood and pocket work, and decoration approval.
Bulk cutting should wait for written pre-production sample approval covering fleece, hood, pocket and decoration together, and bulk fleece should be checked for shade, brushing and lot approval before cutting.
Confirm the mill sequence for dyeing, pre-shrinking and brushing in writing, because mills order those steps differently and a bulk roll must match the sample in shade, brushing and hand feel.
Agree decoration approval, inspection stages, AQL levels, inspector booking and a correction and re-inspection window before production starts, and leave time for them before loading.
Transit must be read from a dated forwarder estimate for the exact route and port pair, never as a fixed number of days, and supplier replies should be compared on the same stage table, priced to the same delivery term.
A hoodie order slips in places a lighter knit order does not: the fleece must be knit, brushed and dyed before cutting, the hood and pocket must hold their shape, and a chest print or embroidery must be approved on the right panel at the right point. A buyer who reads only the total weeks in a quote cannot see which point is holding the order. This guide gives a method for reading a hoodies and sweatshirts lead time from Bangladesh as dated stages, so a supplier reply can be compared and planned around.
Why this matters for buyers and sellers
For a buyer, lead time decides whether hoodies and sweatshirts reach the selling window they were bought for: a winter drop, a team kit issue or a retail season. Work backward from the date the garments must be in hand and cleared, rather than forward from the order date.
For a seller, a dated stage table is a stronger offer than a short total: naming each stage, its approver and its dates lets the buyer plan, and matters here because a pilling brushed face, a twisting hood, an off-center pocket or a cracking print each send an order back for correction.
Step-by-step: how it works

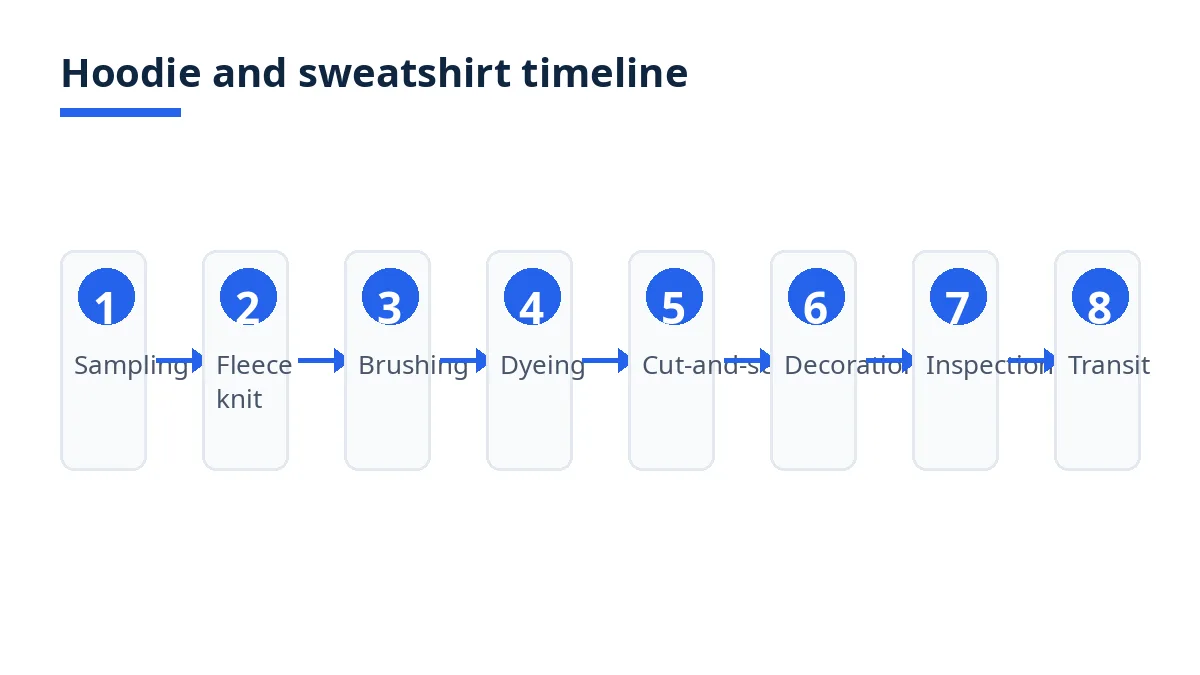

Read any supplier timeline against eight stages: sampling, fleece knitting, brushing and finishing, dyeing and shade approval, cut-and-sew, print or embroidery approval where ordered, inspection, and transit. If a reply skips a stage, ask where that work sits.
Stage 1: Sampling and hood approval
Sampling turns a tech pack into a physical hoodie or sweatshirt the buyer can approve. Fit samples are measured against the fit requirement, pre-production samples are checked for actual trims and for whether earlier comments were incorporated, and size set samples are made in each size before bulk cutting is approved.1 For a hoodie, the sample must also settle hood depth and shape, hood-to-body join, kangaroo pocket position, cuff and hem recovery, and drawstring or zip function. Record four dates per round: tech pack receipt, sample shipment, buyer comments, and approval or rejection.
Stage 2: Fleece knitting
Fleece is knit before it is brushed, dyed, cut or sewn. One published fleece process overview describes the chain as yarn selection, knitting, brushing or raising to create the pile, dyeing or garment dyeing, cutting and sewing, washing and finishing treatments, quality control, and labeling and packaging.2 Use that sequence to read a quote, not as a promise about any mill: confirm in-house knitting or bought greige fleece, two-thread or three-thread fleece, and the GSM range. Fleece weights in that overview are grouped as lightweight, midweight and heavyweight bands, and the tech pack should state GSM, fiber content, knit type and brushing detail.2
Stage 3: Brushing and finishing
Brushing gives fleece its soft inner face. In one sponge fleece account, the fabric is dyed first, then pre-shrunk and dried, then run through a brushing station where ceramic-tipped bristles brush out the material to a smooth, even finish, and only then is it cut and sewn.3 Note the order difference from Stage 2, where brushing sits before dyeing: mills sequence these steps differently, so the quote should state its sequence, the brushed face standard, the pre-shrink treatment, and the bulk hand-feel and pilling check.
Stage 4: Dyeing and shade approval
Dyeing sets color, and shade approval gates cutting. Lap dips are checked and approved for dyed fabrics, and bulk fabric is checked for color against the approved sample and for shade variation across lots, with out-of-shade lots rejected before bulk cutting proceeds.1 Ask which dye route applies, fabric dyeing or garment dyeing, since each carries different shade and shrinkage risks. Cotton fleece, polyester blends and French terry behave differently in dyeing, affecting warmth, drape and printability.4 Agree the lab-dip date, shade tolerance, and replacement route for a rejected lot before cutting starts.
Stage 5: Cut-and-sew
Cut-and-sew joins body, sleeves, hood, pocket, cuffs and hem into a finished garment. Sewing follows a set order: body and sleeves, then hood, pocket, cuff and hem ribbing, and trims. Ask for a weekly update of pieces cut, sewn, finished and packed against target, splitting hood and pocket work from body sewing, where a bottleneck shows up first.
Stage 6: Print or embroidery approval where ordered
Decoration is a gate, not an extra, when it is ordered. Screen printing suits bold graphics, embroidery gives a textured logo finish, and other methods such as sublimation suit polyester-based all-over prints.4 Ask where decoration sits: on cut panels, so a misplaced print costs one panel, or on finished garments, so it costs a finished hoodie. Ask for the strike-off or stitch-out approval date, thread or ink color reference, placement measurement from a fixed point, and correction route for a cracked print or misaligned logo. Strike-offs are checked for print artwork, print colors and embroidery work before bulk decoration proceeds.1
Stage 7: Inspection
Inspection is a stage in its own right, not a formality at the end. During-production checks catch a systematic fault, such as hood twist, pocket misalignment, print cracking or embroidery drift, while remaining units can still be corrected. Agree the standard before production starts. AQL sampling, defined in ISO 2859-1, sets how many garments are inspected from a lot and how many defects of each type are allowed before rejection, with commonly used apparel thresholds of zero for critical defects, 2.5 for major defects and 4.0 for minor defects.5 Agree in writing which faults count as major: a twisted hood, misaligned pocket, broken zip, cracked print and misplaced embroidery. For children's hoodies, treat drawstring safety as critical: over-long drawstrings are listed among critical defects in the same AQL guide.5
Stage 8: Transit
Transit starts when packed, inspected goods are handed to the carrier and ends when they reach the buyer's warehouse, cleared for import. Its variables are sailing or flight schedule, transhipment, port congestion, documentation readiness and destination clearance. No transit leg should be read as a fixed number of days. Ask the forwarder for a dated estimate for the exact route, port pair and service, and what happens if the booked sailing is missed. For containers handed over at a terminal in Bangladesh, FCA, CPT or CIP usually describe the handover more accurately than FOB, CFR or CIF.6

Costs, timelines and documents
How to read a supplier timeline
Ask for a table with five columns: stage, start date, finish date, approval or handover closing the stage, and what happens if that stage slips. Use the table below only as a planning example, not a promise about any supplier, factory or order. Replace every cell with the dated figures in the written quote and forwarder estimate before planning a selling date around it.
Stage | Illustrative planning example | Confirm in writing |
|---|---|---|
Sampling, hood and pocket approval | 2 to 4 weeks across rounds | Ship dates, comment turnaround, approval date |
Fleece knitting and GSM approval | 2 to 4 weeks after approval | Knit type, GSM, fiber content, tolerance |
Brushing, pre-shrink and finishing | Within the fabric stage, as sequenced | Brushing standard, pre-shrink treatment, hand-feel check |
Dyeing, lab dip and shade approval | 1 to 3 weeks, lot by lot | Lab-dip date, shade tolerance, rejected-lot route |
Cut-and-sew, hood and pocket | 3 to 6 weeks after fabric is in hand | Line allocation, weekly reporting, packed-sample approval |
Print or embroidery approval | Before or during sewing, as agreed | Strike-off or stitch-out approval, placement, correction route |
Inspection and correction | 3 to 10 days, plus re-inspection | AQL levels, hoodie major faults, inspector booking, correction window |
Transit and import clearance | Dated forwarder estimate only | Sailing or flight, transhipment, clearance variables |
What moves the cost
Speed costs money: air freight, an expedited dye lot, line overtime or a re-booked inspection all carry a price, and the quote should say whether it is included or extra. Changes cost time and money: a design change after pre-production approval restarts sampling, a color change after dyeing restarts materials, and a decoration change after strike-off or stitch-out approval restarts decoration. Heavier fleece also moves cost through yarn, dyeing, sewing and carton weight, so a GSM change should be re-priced. Payment terms change the start date: a factory waiting for a deposit or letter of credit before ordering yarn starts later than one paid on confirmation.
Documents that gate the timeline
Several documents gate the next stage: the tech pack gates sampling, the approved pre-production sample gates bulk cutting, the inspection report gates loading, and the export documents gate clearance and loading. For export clearance from Bangladesh, the standard export set includes an export contract or purchase order, commercial invoice, packing list, EXP form certified by an authorized dealer bank, certificate of origin, and a bill of export submitted and approved through ASYCUDA World before goods are loaded or stuffed into containers.7 For the buyer, the invoice, packing list, bill of lading or air waybill and certificate of origin are what customs and the carrier ask for first, and any mismatch in quantity, weight, value or description can trigger examination or a hold.7
Bangladesh-specific rules and tips
Confirm three things in every order: the fleece source, knit type and dye-lot route before approving the sample, because stock-fleece sample shade, brushing and hand feel do not prove bulk lots will match; who handles export clearance and which C and F agent is used, because the bill of export and EXP form must be approved before loading;7 and the port and handover point in the delivery term, since containers are commonly handed to the carrier at a yard, depot or terminal, so a matching term such as FCA often describes the real operation better than a sea-only term.6
Mistakes and red flags
The most common mistake is treating a single total as a plan. A reply giving only a number of weeks, with no stage dates, approval points or correction route, cannot be managed. A second mistake is approving bulk from a photo: a photo cannot show brushed hand feel, hood drape, pocket alignment, rib recovery or print hand. A third mistake is booking freight before inspection passes, leaving the buyer paying for a missed sailing or storage if inspection fails. A fourth, specific to hoodies and sweatshirts, is approving the body fleece while leaving hood shape, pocket placement and decoration approvals open: the garment is not approved until all of them are approved together on the same sample. Red flags deserve a direct question: stages all starting the same day usually means they were not sequenced; inspection on the same day as loading leaves no correction window; and transit as a single fixed number of days, with no route, port pair or forwarder estimate, is a guess, not a plan.
Checklist
Use this checklist before confirming an order.
Tech pack: fleece type, GSM, fiber content, knit type, brushing, measurements, size chart, colors, hood, pocket, cuffs, hem, drawstring or zip, artwork, labels, packing
Sample plan: sample types, ship dates, comment turnaround, joint approval of fleece, hood, pocket and decoration, bulk-cut start point
Fleece: knit source, GSM and tolerance, brushing standard, pre-shrink treatment, dye-lot route, shade approval, rejected-lot route
Decoration: placement measurement, strike-off or stitch-out approval, color reference, correction route for a cracked print or misaligned embroidery
Production: line allocation, weekly reporting, hood and pocket slot, decoration slot, effect of an inserted order
Inspection: stages, AQL levels, hoodie major faults, drawstring safety rule where applicable, inspector booking, correction and re-inspection window
Documents: draft invoice and packing list checked against the inspection report, C and F agent named
Delivery term: rule, named place and edition, for example FCA Chattogram, Incoterms 2020
Transit: dated forwarder estimate for the exact route and port pair, missed-sailing route stated
Selling date: buffers after inspection and before the selling window, holidays and peak periods included
Change route: what restarts sampling, knitting, dyeing and decoration, and who pays after pre-production approval
How Exportain helps
Exportain helps buyers turn a supplier timeline into a comparable, written plan: post a sourcing requirement with the tech pack, quantity, target dates and delivery term, and compare supplier replies on the same stage table rather than on a single total.
FAQs
What should I know first about hoodies and sweatshirts?
Lead time is a chain of stages, not a single figure, and for hoodies and sweatshirts the chain has extra gates: fleece knitting, brushing, dyeing, hood and pocket work, and decoration. Sampling approves the garment, fleece and dyeing approve the fabric, cut-and-sew makes the garments, decoration approval approves the print or embroidery, and inspection approves the packed shipment.
What are the typical costs and timelines?
There is no single figure fitting every hoodies and sweatshirts order, so treat any single number with caution and ask for the order-specific version. Costs move with fleece weight, fiber content, quantity, decoration, inspection, freight and the delivery term, and the timetable moves with sample revisions, knitting, brushing, dye lots, hood and pocket work, decoration approvals, inspection results and the forwarder's dated estimate. Use the illustrative table only to structure the questions, then replace every cell with the written quote.
Which documents are needed?
The documents gating the order are the tech pack and size chart, the approved pre-production sample, the inspection report, and the export document set. For export clearance from Bangladesh, that set commonly includes the contract or purchase order, commercial invoice, packing list, EXP form, certificate of origin and bill of export, approved through ASYCUDA World before loading.7 Keep the invoice, packing list, bill of lading or air waybill and certificate of origin consistent with the inspection report, because a mismatch in quantity, weight, value or description can hold a shipment at the port.7
What are the most common mistakes?
The most common mistakes are accepting a single total with no stage dates, approving bulk from a photo, booking freight before inspection passes, approving body fleece while leaving hood, pocket and decoration approvals open, and treating transit as a fixed number of days. Each removes the point where a problem could be caught early: sampling catches a fit error, fleece and shade checks catch a fabric error, decoration approval catches a print or embroidery error, and inspection catches a production error. Put a dated check at each point.
Next steps on Exportain
Write the tech pack, fleece specification, quantity, target date and delivery term into one requirement, then ask each supplier for the stage table in this guide.
Post a free RFQ on Exportain at https://exportain.com/rfqs with that requirement, browse suppliers at https://exportain.com/suppliers, and confirm the delivery term in the Incoterms guide at https://exportain.com/blog/incoterms-for-shipments-from-bangladesh before signing.
Sources
- Preproduction Inspection Stages Followed by Buying House. Online Clothing Study (accessed )
- Premium Fleece Sweatshirts — Made in Portugal. Athleisure Basics (accessed )
- How Our Sponge Fleece is Created – Beyond the Blank. BELLA+CANVAS (accessed )
- How To Manufacture A Hoodie: Step-by-Step Custom Guide. Ninghow (accessed )
- AQL Inspection in Apparel: A Practical Guide (2026). Wave PLM (accessed )
- Incoterms for Shipments From Bangladesh. Exportain (accessed )
- Custom Clearance in Bangladesh: Port Procedures and C and F Agent Guide. Bizmend (accessed )
- Incoterms
- export documents
- knitwear
- quality control
- buyer guide
- Bangladesh sourcing
- aql inspection
- bangladesh garments
