Electrical Cables Lead Time From Bangladesh: Production and Shipping Timeline
Electrical cable lead time from Bangladesh, stage by stage: copper and extrusion gates, testing and certification, drum winding, export clearance and transit, with illustrative ranges and a buyer checklist.
Short answer
Electrical cable lead time from Bangladesh is set by a chain of gates, not a single date: copper and compound supply, extrusion, routine and type testing, drum winding, export clearance and transit. Ask each supplier for dated commitments per stage, the test evidence per drum, and the drum lengths agreed before winding, then compare quotations only on the same specification and delivery term.

On this page
Key takeaways
Cable lead time is set by copper and compound supply, extrusion, testing, drum winding, export clearance and transit, so plan around stage dates, not a single promised date.
Power cables for 1 kV to 30 kV sit on the BSTI mandatory list as BDS IEC 60502 Parts 1, 2 and 4:2018, so confirm the standard route for each market before sampling.
Agree conductor class, voltage class, drum lengths and the test evidence per drum in writing before production starts.
All stage durations in this guide are illustrative ranges for planning; replace each line with the supplier's dated commitment for your order.
Exportain verification is a document and photo review, not a factory inspection, and a badge is not a guarantee.
An electrical cable order from Bangladesh does not move at one speed. The cable looks like a simple product, but its timeline is set by a chain of gates: copper and conductor supply, insulation and extrusion, routine and type testing, drum winding and packing, export clearance and transit. A change to conductor size, voltage class or drum length late in the chain can restart part of that work, so the schedule should be planned around the gates, not around a single promised date.
This guide gives a realistic timeline for electrical cable orders from Bangladesh. It explains each stage, what to ask for in writing, which documents to prepare, and which mistakes most often add weeks. Figures labeled as illustrative are for planning only, not supplier promises. In the Harmonized System, heading 8544 covers insulated wire, cable and other electric conductors, with or without connectors fitted, and optical fiber cables of individually sheathed fibers.1 Conductors themselves are classified by construction: IEC 60228 divides conductors into classes 1, 2, 5 and 6, with classes 1 and 2 intended for fixed installations and classes 5 and 6 intended for flexible cables.2
Why this matters for buyers and sellers
For the buyer, lead time decides project dates, site work and cash flow. Cable that arrives after the installation window is stock without a site, and cable wound in the wrong drum lengths can leave short offcuts that cannot be used on long runs. For the seller, lead time protects the production plan: copper rod is drawn and stranded against your specification, extrusion lines run in planned blocks, and test slots are booked against agreed standards, so a late change to size, voltage class or sheath type restarts part of that chain.
Two controls keep the schedule honest. The first is a written inspection and test plan agreed before production, naming which routine tests run on every drum and which type test evidence covers the design. The second is one delivery term for every quotation: the Incoterms 2020 rules set out 11 rules with a clear allocation of cost, risk and obligations.3 Compare timelines only on the same term, because a supplier quoting EXW and a supplier quoting DDP are quoting different end points.

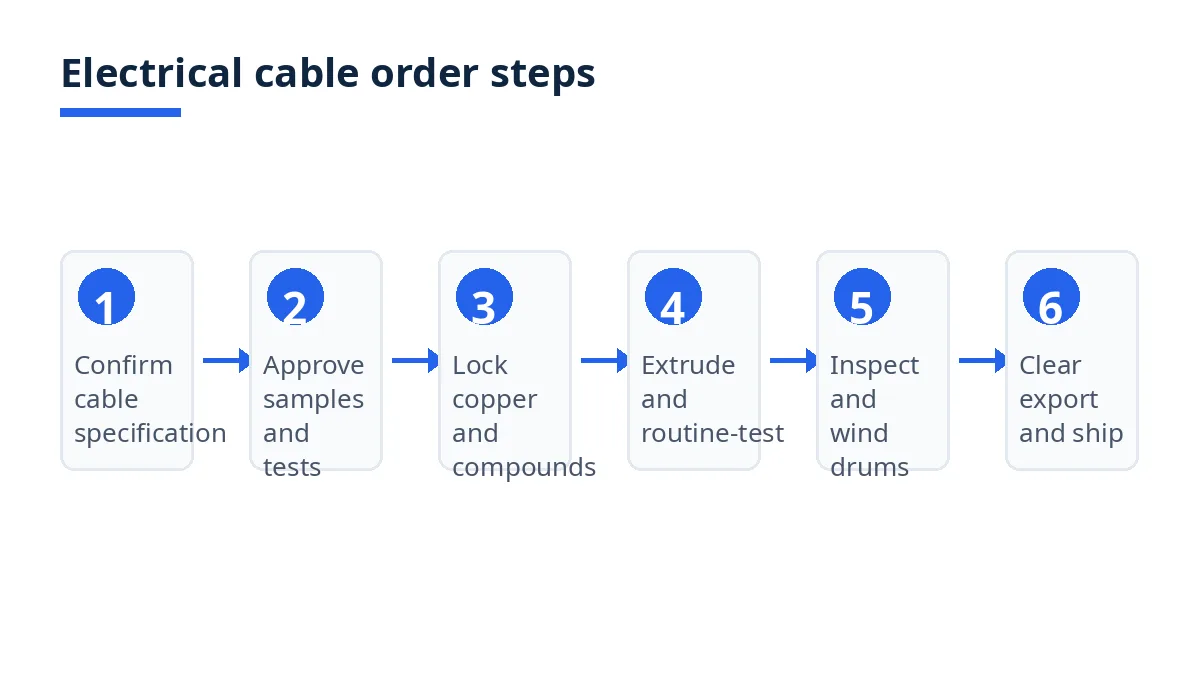

Step-by-step: how it works

Confirm one written cable specification. State conductor material and class, cross-section, number of cores, voltage class, insulation and sheath compounds, armouring if any, applicable standard, drum lengths, marking and destination markets. Name the test and certification route for each market before sampling.
Approve samples and test evidence in stages. Order a sample length in the actual conductor, insulation and sheath, then a pre-production length from the planned line. Check conductor resistance, insulation thickness and marking, and approve or list corrections in writing. Record which test reports will accompany the shipment.
Lock copper and compound supply. Ask which copper rod, insulation compound and sheath compound are stocked, which are ordered in, and what each order quantity covers. A conductor material change after approval is a new sample, not a substitution.
Run extrusion with routine tests. Agree hold points for incoming conductor lots, first-length approval, in-line thickness and diameter checks, and routine electrical tests on finished lengths. Record failures by cause: conductor, insulation, sheath, armouring or marking.
Inspect and wind onto drums. Inspect against the agreed plan, then wind to the agreed drum lengths with end sealing, drum marking and a drum schedule that lists the length and test result for each drum. Short lengths and mixed drums should be agreed before winding, not discovered at loading.
Clear export. Prepare the export set and confirm the booking. Goods may not be loaded unless an export declaration, the Bill of Export or Shipping Bill, is submitted to Customs and approved.4
Ship on the agreed term. Confirm the vessel booking, the named place under the chosen Incoterm,3 and the document set the buyer needs for import clearance, including the drum schedule and test reports.
Costs, timelines and documents
What are the typical costs and timelines?
There is no single typical cost or timeline for electrical cables from Bangladesh, because conductor material and size, voltage class, insulation and sheath compounds, armouring, drum lengths, order quantity, test route and delivery term each move the figure. A supplier quoting without your conductor class, voltage class and drum lengths is quoting a different cable.
Example figures: the table below shows how one order can be planned. It is illustrative only, and each line should be replaced by the supplier's dated commitment for your order.
Stage | Example duration | What gates it |
|---|---|---|
Specification and quotation | 1 to 2 weeks | Complete spec, voltage class and market list |
Samples and test evidence | 2 to 4 weeks | Conductor availability, correction rounds, test slots |
Copper and compound ordering | 2 to 5 weeks | Stock position, order quantity, copper price validity |
Extrusion and armouring | 2 to 4 weeks | Line capacity, drum changeovers, rework |
Routine tests and inspection | 1 to 2 weeks | Test results, failed-length rework |
Drum winding and packing | 1 to 2 weeks | Drum supply, drum lengths, marking |
Export clearance and transit | 2 to 5 weeks | Booking, route and destination port |
For costs, ask for separate lines: copper conductor, insulation and sheath compounds, armouring, drums and packing, testing, inspection, inland transport, freight and insurance under the chosen term.3 A lump sum hides which gate is expensive, and copper movement between quotation and order can change the conductor line, so ask how long the quoted price holds.
Which documents are needed?
For export clearance in Bangladesh, goods may not be loaded unless an export declaration, the Bill of Export or Shipping Bill, is submitted to Customs and approved.4 Enclosed documents include the export contract or purchase order where there is no export letter of credit, the commercial invoice, the packing list, the EXP form certified by an authorized dealer, and a certificate of origin issued by the EPB or a Chamber of Commerce and Industry.4
For the cable itself, keep a separate file: the agreed specification, sample approvals, conductor and compound records, routine test reports by drum, type test evidence where the design requires it, standard and certification records for each market, the inspection report, and the drum schedule. The buyer also needs the import set for the destination market, including tariff classification under heading 8544.1
Bangladesh-specific rules and tips
Check the standard route before you fix the schedule. Power cables with extruded insulation for rated voltages from 1 kV up to 30 kV appear on the Bangladesh Standards and Testing Institution mandatory list as BDS IEC 60502 Parts 1, 2 and 4:2018, covering 1 kV and 3 kV cables, 6 kV to 30 kV cables, and test requirements on accessories.5 The same list carries PVC insulated cables for electric power and lighting as BDS 900:2010.5 Confirm which Bangladesh Standard applies to your cable type, and whether your destination market asks for the IEC route, the BDS route, or both, because a second route can add a separate test slot.
Match the voltage class to the standard part. IEC 60502-2 specifies the construction, dimensions and test requirements of power cables with extruded solid insulation from 6 kV up to 30 kV for fixed installations such as distribution networks or industrial installations.6 A cable quoted to the wrong part, or to a voltage class outside the agreed range, is a different design and a different test plan, not a paperwork change.
Ask which inputs are stocked for your order. Copper rod, insulation compound, sheath compound, armouring wire and drums may be stocked or ordered in for your specification, and an ordered-in input can set both the earliest production date and the price validity window. Agree the drum lengths per size before production, because a drum change after winding wastes length and line time.
Keep one legal name across every paper. The export declaration names the exporter and the foreign buyer,4 so the name on the trade licence, quotation, proforma invoice and payment account should match. A name mismatch is a common cause of a clearance delay that looks like a production delay.
Mistakes and red flags
What are the most common mistakes?
Comparing timelines on different delivery terms. A timeline quoted EXW ends at the factory gate, while a timeline quoted DDP ends at the buyer site. Compare only replies to the same specification on the same Incoterm.3
Changing the conductor or voltage class after approval. A new cross-section, conductor class or voltage class can mean new routine test settings and, in some cases, new type test evidence. Treat any such change as a re-plan, with a new dated commitment.
Ignoring drum lengths. Cable sold by total length but wound in the wrong drum lengths can leave unusable offcuts on site. Agree the length per drum, the number of drums and the tolerance for short lengths before winding starts.
Accepting a verbal delivery date. Record the dated commitment per stage: sample date, material ready date, production dates, test date, inspection date and loading date. A single delivery week hides which gate slipped.
Treating a profile or a badge as a test result. A profile is a starting point for enquiries. It does not test whether a factory can make your cable to the agreed standard, and a badge is not a guarantee of capacity, quality or delivery.7 8
Skipping the drum-by-drum test record. Routine test reports tied to drum numbers are the last control before the cable becomes your installed stock. A shipment without them leaves a fault to be found on site.
Checklist
Before you confirm, every line should be answered in writing.
Specification sent: conductor material, class and cross-section, cores, voltage class, compounds, armouring, standard, drum lengths, marking.
Test route named per market: IEC route, BDS route, or both, with routine and type test evidence listed.6 5
Copper, compound, armouring and drum stock positions recorded: stocked or ordered in, with price validity dates.
Sample length and pre-production length measured and approved in writing, with test reports attached.
Production dates agreed per stage, not as a single delivery week.
Inspection plan and drum schedule agreed, with test results recorded per drum.
Quotations compared on the same specification and Incoterm.3
Export set agreed: invoice, packing list, EXP form, certificate of origin, Bill of Export.4
Drum lengths, short-length tolerance and marking agreed before winding.
How Exportain helps
On Exportain, browse suppliers and post a request for quotation (RFQ) on the RFQ board with your cable specification, drum lengths and delivery term, so suppliers quote against the same specification. Ask each reply for its stage-by-stage dates, copper and compound stock position, and test evidence per drum. When you accept a quotation, Exportain creates one order and issues one proforma invoice from the accepted terms.7
Read the badges for what they record. Exportain Verified means Exportain has checked identity, phone, email and business registration, and Export Verified means it has checked the Export Registration Certificate (ERC).8 Factory Verified means it has reviewed photos of the manufacturer factory, while Trading Company Verified means it has reviewed photos of the trading company office or warehouse.8 Verification is a document review by staff, free, and never granted by membership plans.7 It is not a factory inspection,7 8 so sample approval and drum-by-drum test records stay with you. See how supplier verification works on Exportain.
FAQs
What should I know first about electrical cables?
Know the cable before you ask for a date. Conductor material, class and cross-section, voltage class, insulation and sheath compounds, armouring, applicable standard and drum lengths all move the timeline, because copper supply, extrusion, testing and drum winding each run on their own schedule. Insulated wire and cable sit under HS heading 8544,1 and conductor classes 1, 2, 5 and 6 under IEC 60228 set whether the conductor suits fixed installation or flexible use.2
What are the typical costs and timelines?
There are no typical figures a buyer can rely on, because each factory sets its price and lead time for your specification. Conductor material and size, voltage class, compounds, armouring, drum lengths, test route and delivery term drive the price,3 and copper ordering, extrusion capacity, test slots and drum supply drive the timeline. Use the illustrative stage ranges in this guide for planning, then replace each line with the supplier's dated commitment.
Which documents are needed?
The order documents are the specification, itemized quotation and purchase order, with stage dates and drum lengths on both. The export set is the Bill of Export, commercial invoice, packing list, EXP form certified by an authorized dealer, and a certificate of origin issued by the EPB or a Chamber of Commerce and Industry.4 The cable file adds sample approvals, routine test reports by drum, type test evidence where required, and the drum schedule.
What are the most common mistakes?
The most common mistakes are comparing timelines on different delivery terms,3 changing the conductor or voltage class after approval, ignoring drum lengths, accepting a verbal date, and reading a badge as a guarantee. A badge is not a guarantee of capacity, quality or delivery.7 8
Next steps on Exportain
Browse suppliers, then post your cable specification, drum lengths and delivery term on the RFQ board so suppliers state their stage-by-stage dates. Before you confirm, read how to import electrical cables from Bangladesh and the electrical cables MOQ guide.
Sources
- Classification Detail — HS Code 8544. United Nations Statistics Division (accessed )
- IEC 60228. Wikipedia (accessed )
- Incoterms® 2020. International Chamber of Commerce (ICC) (accessed )
- Customs Clearance Procedures for Export. Bangladesh Customs, National Board of Revenue (accessed )
- BSTI Mandatory Product List 2025. Bangladesh Standards and Testing Institution (accessed )
- IEC 60502-2:2014 Power cables with extruded insulation and their accessories for rated voltages from 1 kV up to 30 kV - Part 2. International Electrotechnical Commission (accessed )
- Trust & Safety Center. Exportain (accessed )
- Supplier verification: Earn trust badges buyers can see. Exportain (accessed )
About the author
Sourcing from Bangladesh?
Post a request for quotation and suppliers on Exportain can send you their quotes directly.
Post an RFQ
