Cotton T-Shirts Lead Time From Bangladesh: Production and Shipping Timeline
How to read a cotton T-shirt lead time from Bangladesh: sampling, materials, production, inspection and transit as dated stages, with a stage table, document checks and red flags to check before ordering.
Short answer
A cotton T-shirt lead time from Bangladesh is a chain of dated stages: sampling approval, fabric and trim sourcing, cutting and sewing, finishing, inspection, packing, export clearance and transit. No single figure fits every order. Ask each supplier for dated stages, named approvals, a correction route and a forwarder estimate, then work backward from your selling date with a buffer after inspection.

On this page
Key takeaways
A cotton T-shirt lead time is a chain of dated stages, not a single number: sampling, materials, production, inspection and transit, each with its own approval or handover.
Bulk cutting should wait for written pre-production sample approval, and bulk fabric should be checked for shade and lot approval before cutting.
Agree inspection stages, AQL levels, inspector booking and a correction and re-inspection window before production starts, and leave time for them before loading.
Transit must be read from a dated forwarder estimate for the exact route and port pair, naming sailing, transhipment and congestion variables, never as a fixed number of days.
Compare supplier replies on the same stage table, priced to the same delivery term, and work backward from the selling date with a buffer after inspection.
A cotton T-shirt lead time from Bangladesh is best read as dated stages, not as a single number. Sampling, materials, cutting and sewing, finishing, inspection, packing, export clearance and transit each have their own start, finish and dependency, and a delay in any stage moves every stage after it. This guide shows how to read that chain, what to ask at each handover, and how to turn a supplier reply into a timetable to plan around.
Why this matters for buyers and sellers
For a buyer, lead time decides the selling season. A shirt ordered for a summer drop, a school term or a retail promotion is useful only if it arrives, clears import customs and reaches the warehouse before that window opens. Working backward from the on-sale date, rather than forward from the order date, protects that window.
For a seller, a clear timeline is a sales tool as much as a production plan. A supplier who states each stage, names who approves what, and puts dates in writing gives the buyer something to compare and to hold the factory to. The offer with dated stages and a written correction route usually wins, even when its total looks longer, because the buyer can see where time will go and where it can be recovered. The garment sequence in Bangladesh runs from inquiry and tech pack review through fabric sourcing, sampling, cutting, sewing, quality control, finishing, packing and export shipment.1

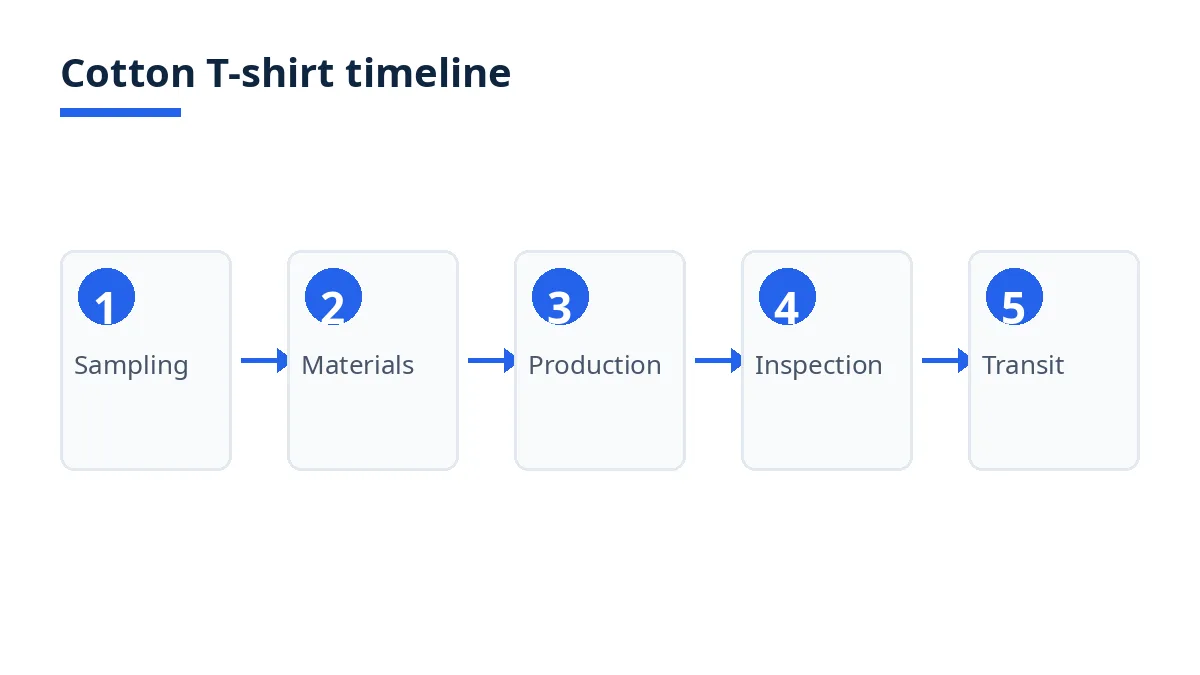

Step-by-step: how it works
Read any supplier timeline against five stages, in this order: sampling, materials, production, inspection and transit. If a reply skips a stage, ask where that work sits. If two stages overlap, ask what must be approved before the overlap starts.
Stage 1: Sampling
Sampling turns a tech pack into a physical shirt the buyer can approve. Common types include a development sample, a fit sample, a size set sample and a pre-production sample, and the pre-production sample becomes the approved standard for bulk production.1 Record four dates per round: tech pack receipt, sample shipment, buyer comments, and approval or rejection. Buying-house practice follows the same logic: fit samples are measured against the fit requirement, pre-production samples are checked for actual trims and for whether earlier comments were incorporated, and bulk cutting waits until the size set is approved.2 Until that approval is in writing, bulk production has not really started.
Stage 2: Materials
Materials cover fabric, trims and packaging: knitted cotton jersey or a blend, neck ribbing, thread, labels, hangtags, polybags and cartons, plus print or embroidery inputs where needed. Fabric is the longest materials risk, because dyeing, shade approval and lab testing all sit before cutting. A shade that looks right under factory lighting can fail under store lighting, so ask how shade is approved: against a lab dip, a bulk swatch or a sealed reference, and in what light.
Stage 3: Production
Production runs through cutting, sewing, decoration and finishing. Cutting lays fabric in layers and cuts it to the marker plan, with numbering and bundling so panels reach the right sewing lines.1 Sewing joins shoulders, sleeves, side seams and neck ribbing, with inline checks so defects are caught while the line runs. Ask for a weekly update listing pieces cut, sewn, finished and packed, against target, from week one.
Stage 4: Inspection
Inspection is a stage in its own right, not a formality at the end. It should include checks during production and a final check of packed goods. During-production checks catch a systematic fault, such as measurement drift or print placement error, while remaining units can still be corrected. A final check confirms packed quantities by size and colour, carton ratios, labels, barcodes, measurements and appearance. Agree the standard before production starts. AQL sampling, defined in ISO 2859-1, sets how many garments are inspected from a lot and how many defects of each type are allowed before rejection, with commonly used apparel thresholds of zero for critical defects, 2.5 for major defects and 4.0 for minor defects.3
Stage 5: Transit
Transit starts when packed, inspected goods are handed to the carrier and ends when they reach the buyer's warehouse, cleared for import. The variables that move a transit leg are the sailing or flight schedule, transhipment, port congestion, documentation readiness and destination import clearance. No transit leg should be read as a fixed number of days, because each variable changes with route, season and carrier. Ask the forwarder for a dated estimate for the exact route, port pair and service, and ask what happens if the booked sailing is missed: the next sailing, holding costs, and who pays for storage. The delivery term decides who arranges each leg and where risk passes. Under Incoterms 2020, risk under FOB and CIF passes on board the vessel at origin, even though under CIF the seller also pays freight and minimum insurance to the destination port, while under FCA risk passes when goods are handed to the carrier, which often matches a container handover better.4

Costs, timelines and documents
How to read a supplier timeline
Ask for a table with five columns: stage, start date, finish date, approval or handover closing the stage, and what happens if that stage slips. Without the fourth column, the table never says who must act before the next stage starts. Without the fifth, it hides the cost of delay: a one-week slip in sampling can mean a lost production slot, a new dye lot or a missed vessel.
Use the table below only as a planning example. Every figure is an illustration of how a timetable can be laid out, not a promise about any supplier, factory or order. Replace every cell with the dated figures in the written quote and the dated forwarder estimate for the actual order before planning a selling date around it.
Stage | Illustrative planning example | Confirm in writing before relying on it |
|---|---|---|
Sampling, including revisions | 1 to 3 weeks across rounds | Sample ship dates, comment turnaround and approval date |
Materials, fabric and trims | 2 to 4 weeks after approval | Lot approval, shade approval and replacement route |
Production, cutting to finishing | 2 to 5 weeks after materials are in hand | Line allocation, weekly reporting and decoration slot |
Inspection and correction | 3 to 10 days, plus re-inspection where needed | AQL levels, inspector booking and correction window |
Transit and import clearance | Dated forwarder estimate only | Sailing or flight, transhipment, port and clearance variables |
What moves the cost
Speed costs money: air freight, an expedited dye lot, line overtime or a re-booked inspection all carry a price, and the quote should say whether it is included or extra. Changes cost time and money: a design change after pre-production approval restarts sampling, and a colour change after dyeing restarts materials. Small orders can cost more per unit in time, because setup for a line, a marker and a print screen does not shrink with quantity. Payment terms change the start date: a factory waiting for a deposit, letter of credit or material payment before ordering fabric starts materials later than one paid on confirmation. Compare quotes on the same basis, priced to the same point using the delivery term as the boundary, with exclusions stated as clearly as inclusions.
Documents that gate the timeline
Several documents gate the next stage: the tech pack and size chart gate sampling, the approved pre-production sample gates bulk cutting, the inspection report gates loading, and the export documents gate customs clearance and vessel loading. For export clearance from Bangladesh, commonly required documents include the export contract or purchase order, commercial invoice, packing list, EXP form certified by an authorised dealer bank, certificate of origin and bill of export submitted through ASYCUDA World, with customs approval required before goods are loaded or stuffed into containers.5 For the buyer, the commercial invoice, packing list, bill of lading or air waybill and certificate of origin are what customs and the carrier ask for first, and any mismatch in quantity, weight, value or description can trigger examination or a hold.5 Prepare the set during production, and ask the forwarder to check the draft invoice and packing list against the inspection report before cartons are sealed.
Bangladesh-specific rules and tips
Bangladesh has a deep knitwear base, and cotton T-shirts are a core product of it, with single jersey the standard fabric for T-shirts and tank tops.1 Mills, dye houses, print shops and sewing factories operate in the same industrial areas, but that depth does not remove queues: a dye house with a full book, a print shop waiting on screens, or a factory running a large retail order can push a smaller order back, and the buyer sees that queue only if the supplier reports line allocation honestly.
Confirm three things in every order. Confirm the fabric source and dye lot route before approving the pre-production sample, because a sample from stock fabric does not prove bulk fabric from a new dye lot will match. Confirm who handles export clearance and which C and F agent is used, because the bill of export and EXP form must be approved before loading, and a late document is a missed sailing even when goods are ready.5 Confirm the port and handover point in the delivery term: containers are commonly handed to the carrier at a yard, depot or terminal before loading on board, so a term matching that handover, such as FCA, often describes the real operation better than a sea-only term written for direct on-board loading.4
Mistakes and red flags
The most common mistake is treating a single total as a plan. A reply giving only a number of weeks, with no stage dates, approval points or correction route, cannot be managed. Ask for the stage table, and treat the order as unplanned until it arrives. A second mistake is approving bulk from a photo of a sample: a photo cannot show hand feel, stretch, seam strength or shade under store lighting, and physical review remains the safer approval for a serious order.1 A third mistake is booking freight before inspection passes, leaving the buyer paying for a missed sailing or storage if inspection fails.
Red flags deserve a direct question. A timeline showing sampling, materials and production all starting the same day usually means stages were not sequenced, because bulk cutting cannot start before sample approval and materials are in hand. A timeline with no inspection stage, or inspection on the same day as loading, leaves no correction window. A timeline giving transit as a single fixed number of days, with no route, port pair or forwarder estimate, is a guess, not a plan.
Checklist
Use this checklist before confirming an order, and keep the answers with the order documents so a later dispute can be settled against what was written.
Tech pack complete: fabric, GSM, composition, measurements, size chart, colour references, artwork, labels and packing requirements
Sample plan agreed: sample types, ship dates, comment turnaround, physical approval, and the point at which bulk cutting may start
Materials confirmed: fabric source, dye lot route, shade approval method, trim suppliers, and the replacement route for a rejected lot
Production plan agreed: line allocation, weekly reporting format, decoration slot, and the effect of another order inserted ahead of this one
Inspection agreed: stages, AQL levels by defect type, inspection level, inspector booking, and the correction and re-inspection window
Documents prepared during production: draft invoice and packing list checked against the inspection report, export documents listed, C and F agent named
Delivery term written in full: rule, named place and edition, for example FCA Chattogram, Incoterms 2020, with freight booking responsibility named
Transit estimated by the forwarder: dated estimate for the exact route and port pair, transhipment and congestion variables named, missed-sailing route stated
Selling date protected: buffers after inspection and before the selling season, with holiday closures and peak periods already in the timetable
Change route agreed: what restarts sampling, what restarts materials, and who pays for a change after pre-production approval
How Exportain helps
Exportain helps buyers turn a supplier timeline into a comparable, written plan. Buyers can post a sourcing requirement with the tech pack, quantity, target dates and delivery term, and compare supplier replies on the same stage table rather than on a single total.
FAQs
What should I know first about cotton t-shirts?
Lead time is a chain of stages, not a single figure. Sampling approves the product, materials approve fabric and trims, production makes the shirts, inspection approves the packed shipment, and transit moves it to your warehouse. Ask any supplier for that chain as dated stages with named approval points, because a single total hides where risk sits and where a delay can be recovered.
What are the typical costs and timelines?
There is no single figure fitting every cotton T-shirt order, so treat any single number with caution and ask for the order-specific version. Costs move with fabric, quantity, decoration, inspection, freight and the delivery term, and the timetable moves with sample revisions, fabric lots, line allocation, inspection results and the forwarder's dated route estimate.
Which documents are needed?
The documents gating the order are the tech pack and size chart, the approved pre-production sample, the inspection report, and the export document set. For export clearance from Bangladesh, that set commonly includes the contract or purchase order, commercial invoice, packing list, EXP form, certificate of origin and bill of export, approved through ASYCUDA World before loading.5 Keep the commercial invoice, packing list, bill of lading or air waybill and certificate of origin consistent with each other and with the inspection report, because a mismatch in quantity, weight, value or description can hold a shipment at the port.5
What are the most common mistakes?
The most common mistakes are accepting a single total with no stage dates, approving bulk from a photo, booking freight before inspection passes, and treating transit as a fixed number of days. Each removes the point where a problem could be caught early: sampling catches a design error, materials checks catch a shade error, inspection catches a production error, and a forwarder estimate catches a routing error. Put a dated check at each point, keep a buffer after inspection, and most timeline failures become manageable delays instead of missed seasons.
Next steps on Exportain
Write the tech pack, quantity, target selling date and delivery term into one requirement, then ask each supplier for the stage table in this guide, with dated stages, named approvals and a correction route.
Post a free RFQ on Exportain at https://exportain.com/rfqs with that requirement, browse suppliers at https://exportain.com/suppliers, and confirm the delivery term in the Incoterms guide at https://exportain.com/blog/incoterms-for-shipments-from-bangladesh before signing.
Sources
- Inside Bangladesh Garment Manufacturing Process. Minmax Textile (accessed )
- Preproduction Inspection Stages Followed by Buying House. Online Clothing Study (accessed )
- AQL Inspection in Apparel: A Practical Guide (2026). Wave PLM (accessed )
- Incoterms for Shipments From Bangladesh. Exportain (accessed )
- Custom Clearance in Bangladesh: Port Procedures and C and F Agent Guide. Bizmend (accessed )
- Incoterms
- export documents
- knitwear
- quality control
- buyer guide
- Bangladesh sourcing
- aql inspection
- bangladesh garments
